Blog

Top 7 Construction Project Control Tools: Reviewed

Seven tools, one rigorous framework, and no sugarcoating - here's how the leading construction project controls platforms actually stack up.

"Project controls software" means something different to almost everyone who uses the term. Ask a forensic delay analyst, a VP of Operations at an ENR Top 100 firm, and a project manager at a 20-person GC, and you will get three completely different answers about which tools matter and why.

That is not a coincidence - it is a reflection of how broad the category actually is. The key features of project controls solutions for construction vary enormously depending on whether you are trying to build a schedule, analyze one, manage project costs, or defend a claim.

Buying the wrong tool for the wrong problem is expensive. Not just in licensing costs, but in adoption effort, wasted implementation time, and the opportunity cost of still not having the visibility you actually needed. This review is designed to prevent that.

The seven tools covered here represent the most relevant options in the construction project management and controls landscape today - from the CPM scheduling standard that has anchored the industry for decades to emerging platforms that take fundamentally different approaches to construction project data. Each is reviewed on what it actually does, who it is built for, and where it fits in a mature project controls program.

What "Project Controls" Actually Covers - and Why It Matters Before You Buy Anything

Before comparing any tools, it is worth being precise about what project controls actually include. AACE International, the industry's primary professional body for cost engineering and project controls, defines the discipline as an integrated set of processes covering scope, cost control, schedule, risk management, and change management throughout the project lifecycle. Within that framework, the tools in this review operate across four distinct functional domains - and most only operate in one.

Schedule creation is the development of CPM schedules: defining activities, durations, logic, and task dependencies. Oracle’s Primavera P6 is the dominant tool here for complex projects.

Schedule analytics and diagnostics is the ongoing analysis of schedules for quality, performance, and delay: tracking progress, measuring what happened versus what was planned, identifying risk early, and producing defensible reporting. SmartPM and Deltek Acumen Fuse operate here.

Cost and earned value management (EVM) is the integration of cost, scope, and schedule into a unified performance picture - calculating planned value, earned value, and actual cost to give a real-time view of project financial health. InEight is the most comprehensive tool in this review for this domain.

AI-driven optimization is the use of simulation and machine learning to generate or test schedule scenarios. ALICE Technologies belongs here. It is a fundamentally different use case from monitoring an active construction project.

The confusion most construction teams run into is treating these as interchangeable. A tool that builds excellent schedules does not automatically analyze them well. A platform built for EVM on a $2 billion infrastructure program does not automatically translate to a commercial GC managing 15 projects between $10M and $50M.

The right question is never "which tool is best?" - it is "which tool solves the problem I actually have?"

How We Evaluated These Tools

Each tool in this review was evaluated against eight factors drawn from SmartPM's software review methodology - the same framework we use to assess any project controls platform, including tools that compete with our own. No single tool scores well across all eight, and that is intentional. These categories reflect four distinct functional domains, and most tools are built to serve only one or two of them.

The eight factors and their weighting:

  • Schedule quality analysis (20 points): Does the tool assess whether a schedule is structurally sound - open ends, logic gaps, constraint overuse, float distribution - against recognized standards including the DCMA 14-point check?
  • Analytical engine and data integrity (15 points): Does the tool have its own CPM engine that independently calculates, or is it a visualization layer that reformats data from the source scheduling tool?
  • Delay analysis and forensic capabilities (15 points): Can it support time-impact analysis, as-built vs. as-planned comparisons, and concurrent delay isolation in a way that would hold up in a dispute?
  • Portfolio visibility and reporting (10 points): Can it surface schedule health and risk indicators across all active projects simultaneously, with reporting that serves multiple audiences?
  • Integration ecosystem (10 points): How deeply does it connect with existing construction stacks - P6, MS Project, Procore, Autodesk, CMiC - and does that connection automate data flow or require manual effort?
  • Ease of adoption and time to value (10 points): How quickly can a construction team go from contract to useful data? Implementation complexity is not theoretical - it determines whether a tool gets used.
  • Security, compliance, and data governance (10 points): Does the tool meet the security requirements that government, federal, and institutional owners increasingly mandate? This includes FedRAMP® authorization, SOC 2 compliance, and data residency controls.
  • Value and pricing transparency (10 points): Is pricing published and predictable, or does total cost of ownership only become clear after a sales process?

Scores below 40 indicate a tool that does not meet baseline requirements for serious project controls work. Scores in the 55-69 range reflect capable tools with meaningful gaps for specific use cases. Scores above 85 represent best-in-class capability across the full framework.

A note on context: several tools in this review score lower not because they are poor products, but because the criteria are weighted toward schedule analytics and forensic depth – which is not what every tool is designed to deliver. P6 is best-in-class for schedule creation. InEight is built for capital program EVM. ALICE is a preconstruction optimization tool. Their scores reflect performance against project controls analytics criteria, not their value within their intended use case.

All competitor characterizations in this article are based on publicly available documentation and marketing materials at time of writing. Feature sets evolve, and readers are encouraged to verify current capabilities directly with each vendor.

The 7 Construction Project Control Tools: Reviewed

1. SmartPM - Schedule Analytics and Automated Project Controls

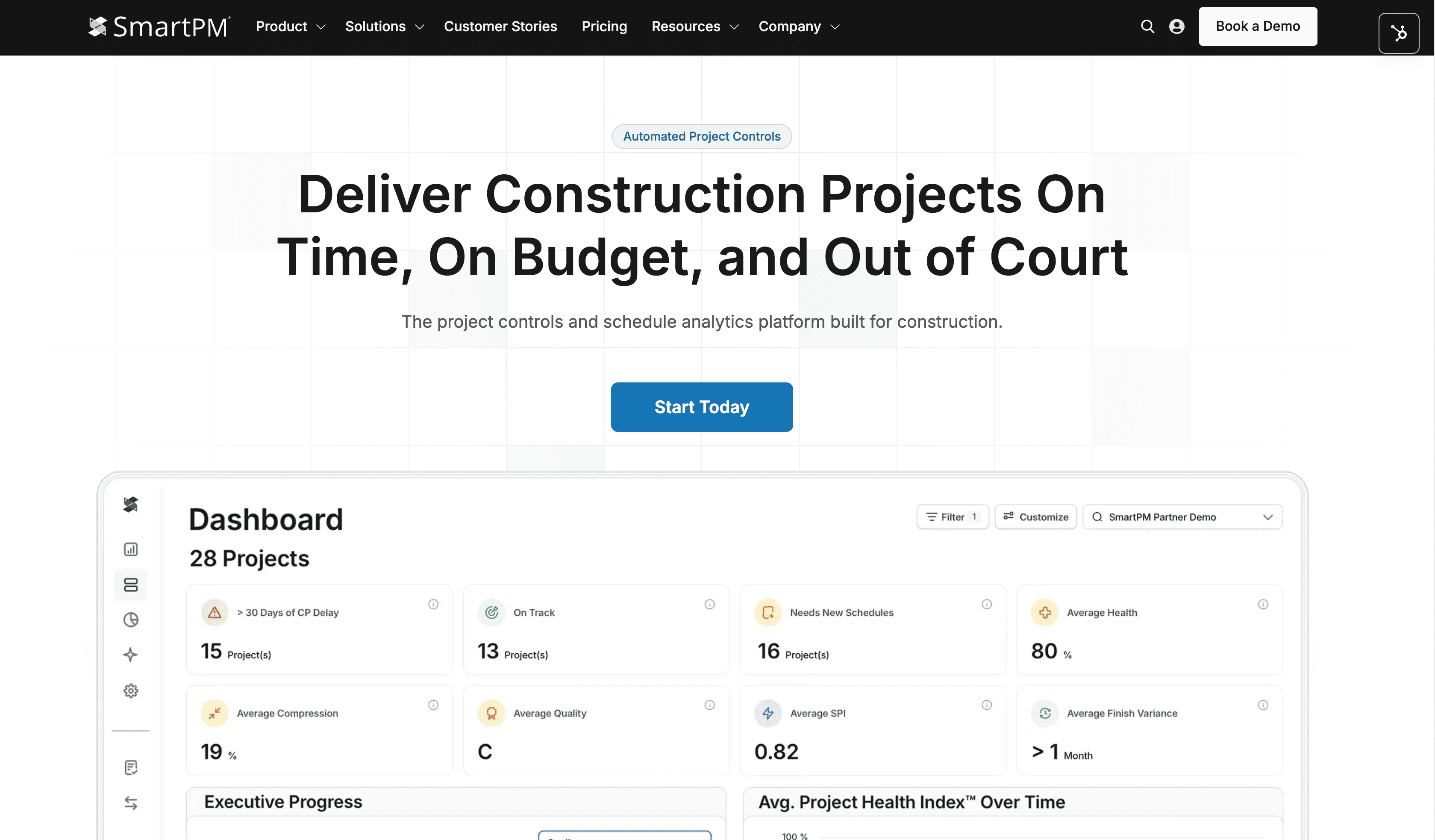

SmartPM Homepage

SmartPM is a schedule analytics platform built by a forensic delay expert with more than 20 years of CPM scheduling and claims experience. It is purpose-built for construction - not adapted from another industry - and it sits at the analytics and performance measurement layer of the construction project management stack.

Where most tools show you what a schedule looks like, SmartPM calculates what it means. The platform is trusted by more than half of the ENR Top 50 and holds FedRAMP® High authorization, making it the credible choice for both commercial GCs and federal programs.

Best For: General contractors, construction project managers, owner organizations, and consultants that need automated schedule analytics, portfolio-level performance visibility, and forensic-grade reporting built on a real CPM engine.

SmartPM Essentials serves mid-market GCs building a controls function for the first time. SmartPM Controls serves project controls teams that need deep analytical depth, forensic delay analysis, and defensible reporting.

Our Score: 93 / 100

Criteria

Score

Schedule Quality Analysis

19/20

Analytical Engine & Data Integrity

14/15

Delay Analysis & Forensic Capabilities

14/15

Portfolio Visibility & Reporting

9/10

Integration Ecosystem

9/10

Ease of Adoption & Time to Value

9/10

Security, Compliance & Data Governance

10/10

Value & Pricing Transparency

9/10

Total

93/100

Key Features

  • Proprietary CPM Engine: SmartPM processes raw schedule data mathematically rather than reformatting outputs from your scheduling tool. Every upload runs through the engine to calculate critical path shifts, compression ratios, schedule performance indices, end date variance, and planned vs. actual progress - giving you analysis that is independently derived and defensible.
  • Schedule Quality Checker: Automatically evaluates every schedule against 35+ CPM quality checks at every update - missing logic, negative float, out-of-sequence progress, constraint overuse, and more. Results are graded by letter, color, or score. Teams can build custom grading profiles by client, division, or project type, and track quality trends over time to catch slippage before it compounds.
  • Schedule Quality Analysis: Goes beyond the DCMA 14-point check to assess logic integrity, duration feasibility, float distribution, and data consistency at the activity level. Flags exactly which activities are hurting the grade and why, with a Gantt overlay view that visualizes the issues inside the schedule layout. The same analysis runs automatically across every update, milestone, or custom-built model in one click.
  • Delay Analysis: SmartPM's automated delay analysis engine breaks down every schedule update into progress delay, gains, and planned impacts - in seconds. Teams can pinpoint which activities drove slippage, evaluate whether recovery efforts are actually holding, and build a day-for-day documentary record suitable for time extension claims and dispute support.
  • Schedule Comparison: Side-by-side comparison of any two schedule updates, showing exactly what changed between periods - activity additions, removals, logic changes, and duration shifts. Designed to surface the critical changes that drove end date movement, not just produce a list of differences.
  • Schedule Performance Trends: Tracks key metrics across every update over the life of the project - quality scores, compression, SPI, end date variance, and critical path delay. Trend visibility is what separates early warning from after-the-fact reporting.
  • Schedule Compression Index: Measures whether the current path to completion is realistic given actual productivity. A plan that pulls dates back on paper without adjusting for what the field can actually deliver shows up here. Useful for identifying overly compressed recovery schedules before they create new problems.
  • Milestone Tracking: Monitors key project milestones at every update with direct visibility into delays, progress, float erosion, and date changes for specific phases. Milestone health and trend data is available across the project history and for any other analysis available in SmartPM.
  • Schedule Change Analysis: Flags and categorizes logic changes, duration changes, and activity modifications between updates. Identifies the changes that drove acceleration or delay - not just a raw change log, but context on what mattered.
  • Predictive Analytics: Forecasts predicted completion dates based on current schedule performance and productivity trends. Gives teams and executives a data-driven view of where the project is actually headed, not just where the current schedule says it will land.
  • What-If Modeling: Creates scenario models on top of live schedule data without touching the source file. Teams can test different workweeks, durations, sequences, and impact events to see how dates, compression, and feasibility would change before committing to a recovery plan or submitting a time extension claim. The live schedule and baseline remain clean throughout.
  • Interactive Gantt Chart: A web-based Gantt with CPM context - not just a bar chart. View critical and near-critical paths, historical critical path shifts, no-progress periods, planned vs. actual performance, and field log data. Filter by trade, phase, custom-built filters, or delay status. Navigate directly to any activity for full detail on dates, logic, float, constraints, and a complete change history. Printable 3 to 6 week lookaheads included. Unlimited users per project.
  • Automated Reporting and Dashboards: Build report templates and dashboards once and reuse them at every update. SmartPM pulls directly from CPM schedules - quality, delay, trends, Gantt views, hit rates, productivity - and packages them into reports configured for each audience: PMs, superintendents, executives, trade partners, or OAC teams. Auto-delivery by email after every upload or analysis, on any cadence, as PDF or Excel.
  • Portfolio Dashboard: Real-time schedule health, risk distribution, quality grades, compression trends, and end date variance across every active and inactive project in a single view. Inactive processing allows for historical benchmarking. Company-level templates standardize what gets reported and how, so every project tells its story in the same language.
  • Open API and Integrations: SmartPM connects natively with Oracle P6, MS Project, Procore, Autodesk, Egnyte, Power BI, Tableau, and Domo. The Open API gives teams programmatic access to both raw schedule data and all calculated metrics - no extra fees, no user limits - for pushing SmartPM analytics into internal dashboards, PMIS systems, ERPs, or custom reporting workflows.
  • Security and Compliance: SOC 2 Type I and Type II certified, ISO 27001 certified, and FedRAMP High authorized. Data is encrypted in transit and at rest. Annual penetration testing, continuous monitoring of 100+ internal security controls, and a security-first development lifecycle. The only schedule analytics platform in construction with FedRAMP High authorization, based on publicly available information at time of writing.

The Project Controls Impact

SmartPM addresses the most expensive gap in how most GCs approach construction project management: the delay between when a problem develops and when anyone knows about it.

When schedule analysis is done manually - pulling P6 exports into Excel, comparing updates by hand - tracking progress happens monthly at best. By then, delay has already been built in. SmartPM automates the entire review and reporting process, turning a schedule upload into a complete analytical picture within minutes.

The practical result is a shift from lagging to leading indicators. Barton Malow Builders described this directly: SmartPM gives their team time to act on risk before it materializes as delay. Rowan Digital Infrastructure reported that report generation dropped from a full day to five minutes. Columbia Ventures used SmartPM to anchor contract negotiations in verified schedule data rather than subjective claims.

Company Dashboard

Integrations

Primavera P6, Procore, Autodesk Construction Cloud, Egnyte, Phoenix Project Manager, Asta Powerproject, CMiC, Power BI. SmartPM is designed to sit on top of existing tools - it does not require replacing them.

Pricing

SmartPM offers two plans: SmartPM Essentials at $12,000/year for unlimited projects and SmartPM Controls for $25,000/year with five control slots.

Pros and Cons

Pros

Cons

Only construction analytics platform with a proprietary CPM engine, based on publicly available documentation

SmartPM Controls requires a minimum five-project commitment - not suited for organizations managing fewer active projects

Forensic delay analysis built in - not an add-on

Depth of the Controls tier may exceed the immediate needs of organizations very early in their project controls journey (Essentials is the appropriate starting point)

FedRAMP High authorization for federal programs

Two tiers scale from mid-market entry to ENR Top 100 sophistication

Customer success team actively helps build project controls programs, not just deploy software

Trusted by more than half of the ENR Top 50

Reviews/Case Studies

Capterra: 4.9 stars out of 5 - 46 ratings

Larry M. says: “I used SmartPM to communicate in an easy-to-understand method my client's schedules progress, concerns, and observations. I had a 2 year experience using SmartPM. I not only got a great tool to work with, but I got a great education on how a P6 schedule can really be used as a tool to manage a project. If I get another similar assignment, I be right back using SmartPM again”

2. Deltek Acumen Fuse - Schedule Diagnostics and Metrics Analysis

Deltek Acumen Fuse Homepage

Deltek Acumen Fuse is a schedule analysis and diagnostics platform with deep roots in the government, defense, and aerospace sectors. It is part of the broader Deltek ecosystem and is designed for organizations operating under rigorous compliance frameworks including DCMA, GAO, DOE, and NASA scheduling standards. For contractors working on federal defense and aerospace programs, Acumen Fuse is frequently a recognized tool in effective project controls conversation.

Best For: Large enterprises, defense contractors, aerospace firms, and government program offices that operate under DCMA, GAO, or NASA scheduling compliance requirements. Based on publicly available documentation, Acumen Fuse is less commonly referenced in the commercial construction GC market than in defense and government sectors.

Our Score: 81 / 100

Criteria

Score

Schedule Quality Analysis

18/20

Analytical Engine & Data Integrity

14/15

Delay Analysis & Forensic Capabilities

13/15

Portfolio Visibility & Reporting

8/10

Integration Ecosystem

8/10

Ease of Adoption & Time to Value

7/10

Security, Compliance & Data Governance

8/10

Value & Pricing Transparency

5/10

Total

81/100

Key Features

  • 500+ Metrics: Covering schedule quality, compliance, performance, and cost/schedule integration
  • DCMA 14-Point Assessment: Built in, along with GAO 9 best practices, DOE PARS support, NASA standard checks
  • Schedule Cleanser: Removes redundancies and corrects identifiable issues to improve quality scores
  • Forensic Analysis: Variance analysis, forensic checks, and change tracking over time
  • Acumen Risk / Risk 360: Monte Carlo simulation for schedule risk quantification (companion product)
  • Multi-Platform Import: Primavera P6, MS Project, Asta Powerproject, Deltek Open Plan, Cobra, and IPMDAR formats

The Project Controls Impact

Acumen Fuse addresses schedule quality and risk analysis at a depth that serves compliance-intensive programs well. The 500+ metric library, DCMA/GAO/NASA standard checks, and Monte Carlo risk simulation through its companion products make it a capable suite for organizations where quality control is audited and outcomes have contractual or regulatory consequences.

The primary context where Acumen Fuse and SmartPM occupy different territory is market focus and organizational fit. Acumen Fuse sits within a large ERP ecosystem primarily serving defense and government contractors. SmartPM was built by and for the commercial construction industry, is designed to be accessible to project teams beyond the specialist, and is built for the GC-centric workflow where multiple projects move simultaneously and speed of insight matters as much as analytical depth.

Integrations

Primavera P6, MS Project, Asta Powerproject, Deltek Open Plan, Deltek Cobra, Safran Project, Phoenix Project Manager, IPMDAR SPD/CPD formats. Strongest integration depth within the Deltek ecosystem.

Pricing

Deltek does not publicly list pricing for Acumen Fuse. Contact Deltek directly for current pricing and licensing terms.

Pros and Cons

Pros

Cons

500+ metrics with deep government compliance standard support (DCMA, GAO, DOE, NASA)

Pricing is not publicly advertised - evaluation requires direct vendor engagement

Strong forensic analysis and logic tracing capability

Based on publicly available documentation, primarily associated with defense/aerospace/government use cases rather than commercial construction GC workflows

Companion products extend into risk quantification and automated schedule submission review

Sits within a large enterprise ecosystem; less commonly referenced for mid-market commercial GC use than purpose-built construction analytics platforms

Broad schedule file format support

Reviews

Capterra: 4.2 stars out of 5 - 29 ratings

Joseph S. says: “Acumen Fuse Is Awesome. It is great to handle our scheduling needs. The flexibility, customization, and function of the software is top notch. It serves al of our purposes and is so much better than Oracle's versions of the software.”

3. InEight - Integrated Cost, Schedule, and EVM for Capital Construction

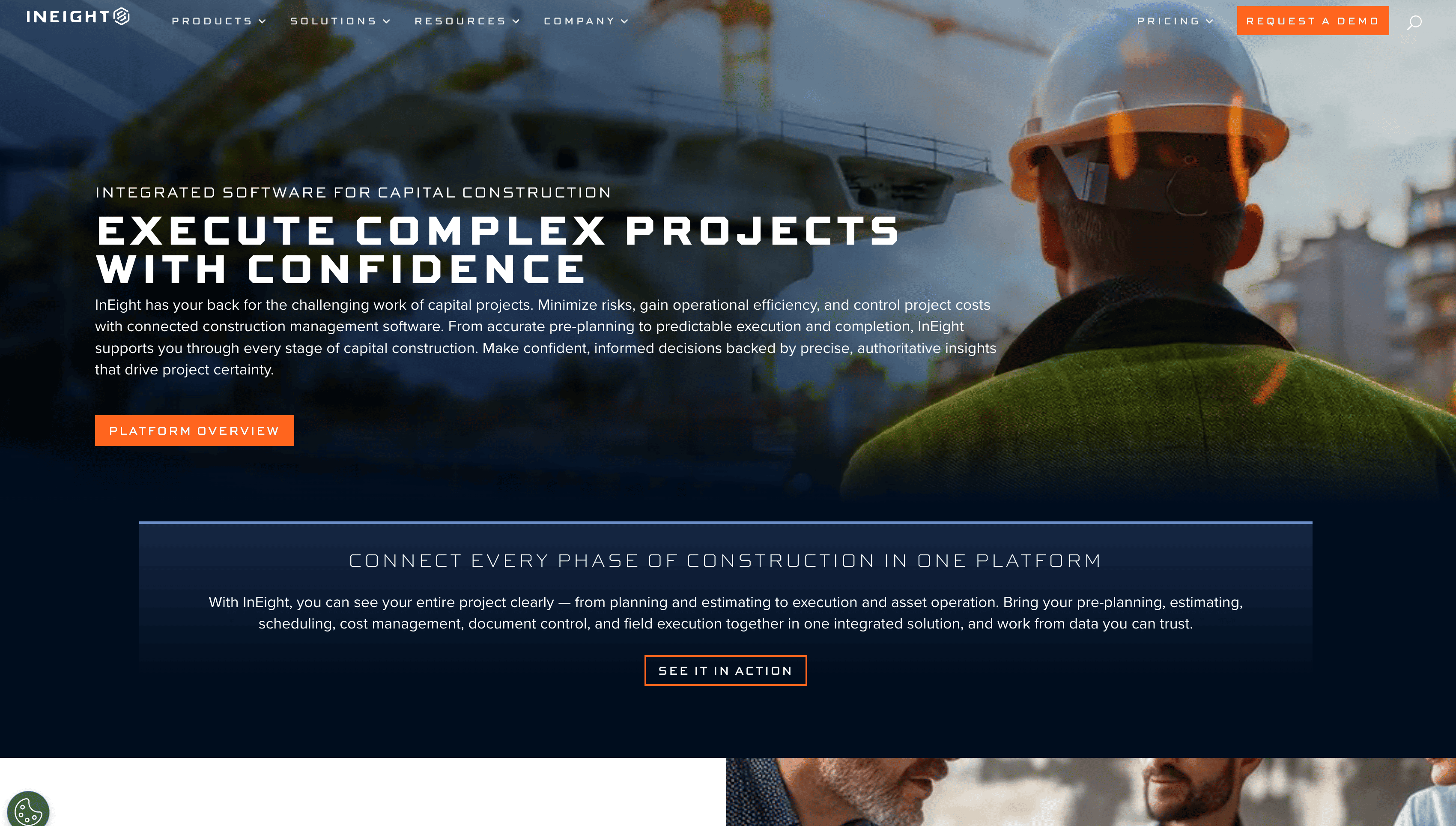

InEight Homepage

InEight is a modular platform designed for large capital construction programs - infrastructure, transportation, power, and industrial - where cost management, earned value, and schedule performance are managed as an integrated system rather than separate workflows. It is a different category of tool from the others in this review, built for program complexity that most commercial GC work does not require.

It is a modular platform, meaning organizations can implement specific capabilities - resource management, scheduling, change management, EVM - rather than adopting everything at once. Its target market is capital construction at scale: infrastructure, transportation, power and renewables, industrial.

One consideration worth noting: InEight is a subsidiary of Kiewit Corporation, an ENR Top 10 general contractor. GCs evaluating the platform should factor that ownership into their data governance review, as project schedule data, performance metrics, and update history would be hosted by a platform owned by a competitor. We recommend verifying InEight's data handling and access control policies directly with the vendor before proceeding.

Best For: Large capital construction programs - infrastructure, highways, utilities, power, and industrial - where the integration of cost management, earned value management, and schedule performance into a single platform is a contractual or organizational requirement. Based on publicly available documentation, InEight is less commonly positioned for commercial GC markets (office, healthcare, multifamily, data center) where SmartPM's customer base is centered.

Our Score: 61 / 100

Note: InEight's score reflects the analytics criteria of this review, which are weighted toward schedule quality, compliance, and forensic depth. InEight's strongest capabilities - cost management and EVM - are underweighted by those criteria. For capital construction programs where EVM is the primary need, InEight's value proposition is higher than this score reflects.

Criteria

Score

Schedule Quality Analysis

8/20

Analytical Engine & Data Integrity

10/15

Delay Analysis & Forensic Capabilities

7/15

Portfolio Visibility & Reporting

9/10

Integration Ecosystem

8/10

Ease of Adoption & Time to Value

5/10

Security, Compliance & Data Governance

8/10

Value & Pricing Transparency

6/10

Total

61/100

Key Features

  • Integrated Cost Management (InEight Control): Budgeting, forecasting, change order management, and actual cost tracking in a unified real-time view
  • Built-in EVM: Planned value, earned value, and actual cost calculations with real-time SPI and CPI reporting
  • Advanced Forecasting: Time-phased budgets, what-if scenario modeling, and variance tracking against baseline
  • Work Packaging: Connects planning to field execution through detailed work package management
  • Portfolio Dashboards: Real-time visibility across programs with drill-down into cost, schedule, and performance metrics

The Project Controls Impact

InEight is built for capital construction programs where cost management and earned value reporting are contractual requirements - infrastructure, industrial, and large public works where EVM is the primary controls discipline. For commercial GCs managing construction projects in the $10M-$50M range, that level of cost/schedule integration is typically beyond what the work requires.

InEight's strength is making those EVM calculations automatic, continuous, and connected to real project data rather than manually assembled from separate systems. Having unified project data flowing through a single platform enables the informed decisions that capital program complexity demands.

For commercial GCs managing construction projects rather than capital programs, the relevant question is whether that EVM depth is required. Most commercial GC project controls work - checking schedules, measuring performance against baseline, identifying delay early, producing owner reporting - is served by schedule analytics tools operating in the $5K-$12K/year range.

Integrations

Based on publicly available documentation, InEight integrates with Primavera P6, Microsoft Project, ERP platforms, and field data capture tools. Open API available. Contact InEight directly for current integration documentation.

Pricing

InEight pricing is configured per organization, based on modules implemented, number of users, and contract length. Pricing is not publicly listed - contact InEight directly.

Pros and Cons

Pros

Cons

The most complete cost/schedule/EVM integration in this review for capital construction

Pricing not publicly disclosed; enterprise-scale investment

Modular - organizations can start with specific capabilities and expand

Based on publicly available documentation, does not appear to advertise the same schedule quality grading depth as purpose-built schedule analytics platforms

Real-time EVM metrics without manual calculation

Implementation complexity may exceed what commercial GCs need for schedule analytics workflows

Strong portfolio-level visibility across large programs

Reviews

Capterra: 4.4 stars out of 5 - 15 ratings

Jhonny D. says: “What I find most appealing is how InEight works to handle several aspects of a project at the same time. This software means that small details of cost estimates will easily be broken down into manageable data that can work well for projects such as those in construction. I have discovered that for some reason, it might take a while to generate its report if a project contains many components. This can be disheartening especially when preparing to submit reports to clients and other parties within a short span of time.”

4. Schedule Validator - Cloud-Based Schedule Quality Scoring

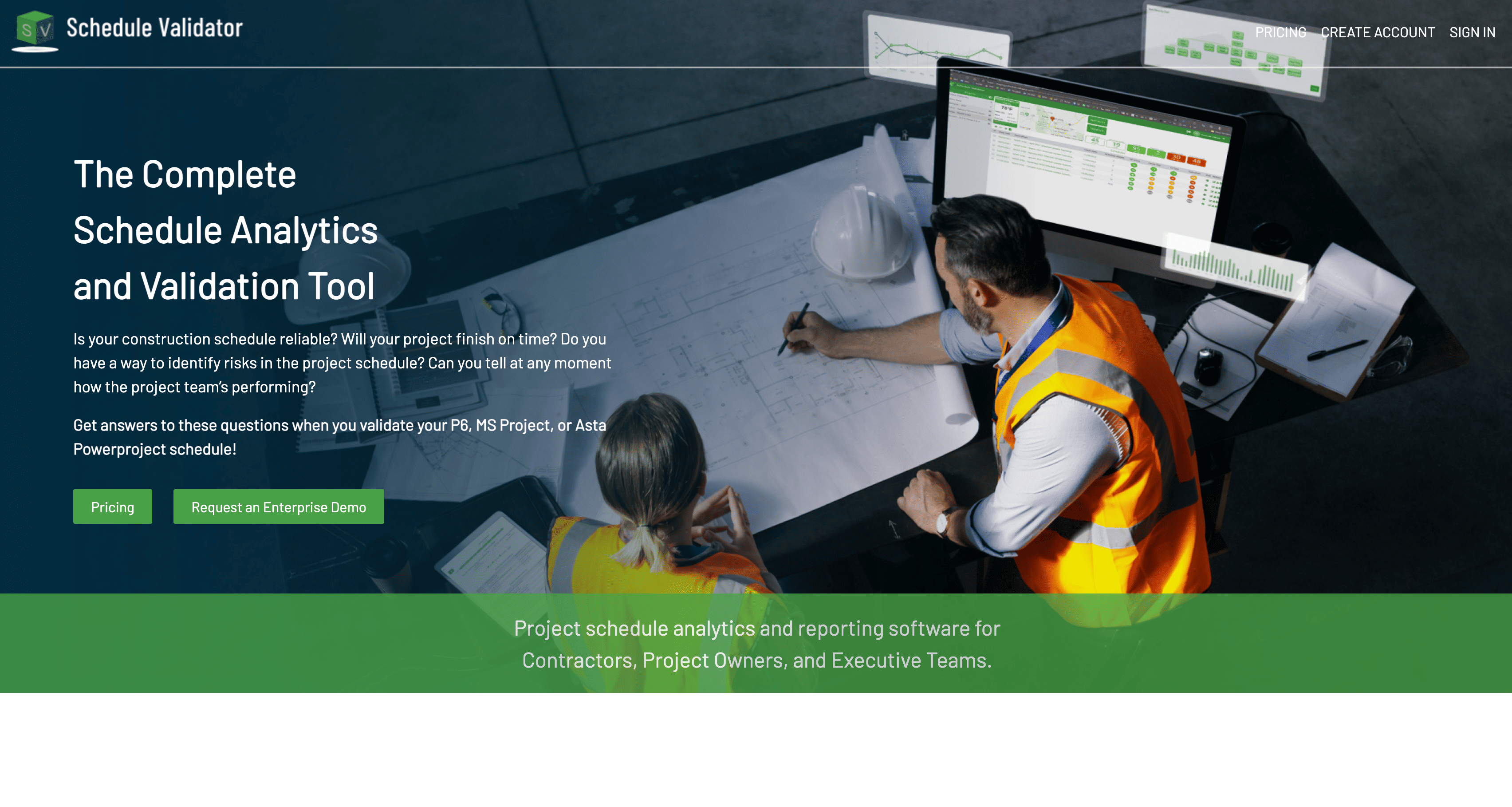

Schedule Validator Homepgae

Schedule Validator is a web-based platform that analyzes P6, MS Project, and Asta Powerproject schedules against quality and compliance standards, producing validation scores, critical path analysis, and performance reporting. It uses a proprietary DCMA+ scoring system that extends the standard DCMA 14-point check. The platform is cloud-based, requires no software installation, and is designed to be accessible to construction teams without a large platform investment.

Best For: Project controls professionals, schedulers, and smaller teams seeking cloud-based schedule quality scoring, DCMA+ compliance checking, and critical path analysis without the overhead of an enterprise platform. Organizations that primarily need the upload-analyze-report cycle for schedule quality checking will find it well suited to that workflow.

Our Score: 61 / 100

Criteria

Score

Schedule Quality Analysis

15/20

Analytical Engine & Data Integrity

9/15

Delay Analysis & Forensic Capabilities

7/15

Portfolio Visibility & Reporting

7/10

Integration Ecosystem

5/10

Ease of Adoption & Time to Value

9/10

Security, Compliance & Data Governance

5/10

Value & Pricing Transparency

4/10

Total

61/100

Key Features

  • DCMA+ Scoring: Proprietary extension of the standard DCMA 14-point check; generates a Schedule Validation Score on upload
  • Schedule Execution Index: Tracks execution performance from update to update and baseline to update
  • Critical Path Analysis: Comparison reports showing critical path progress and changes between schedules
  • Three Dashboard Views: Schedule Dashboard, Project Dashboard, and Enterprise Dashboard for different levels of visibility
  • Schedule Diagnostics: Identifies schedule anomalies with narrative generation capability
  • Cloud-Based: No installation required; accessible via desktop and mobile

The Project Controls Impact

Schedule Validator handles the core schedule quality workflow - upload, validate, score, report - in a straightforward, accessible way. For project controls teams that need DCMA+ scoring and critical path analysis without building an enterprise-scale analytics program, it fills that gap at a price point and accessibility level that reflects the scope of the use case.

The meaningful differences between Schedule Validator and SmartPM center on analytical depth and organizational scale. SmartPM's proprietary CPM engine processes schedule data mathematically rather than operating primarily as a scoring and reporting layer.

SmartPM also includes forensic delay analysis capability, direct integrations with Procore, Egnyte, Autodesk, FedRAMP High authorization, and an enterprise customer success infrastructure. Organizations evaluating both should verify current feature sets directly with each vendor.

Integrations

Based on publicly available documentation, Schedule Validator supports schedule file uploads from Primavera P6, MS Project, and Asta Powerproject. Native integrations with project management platforms such as Procore or Autodesk are not prominently advertised in publicly available documentation at time of writing.

Pricing

Schedule Validator offers tiered pricing for individuals and enterprise teams. A 30-day free trial of all professional features is available. Contact Schedule Validator for current pricing tiers.

Pros and Cons

Pros

Cons

Cloud-based with no software installation required

Based on publicly available documentation, does not appear to advertise the same proprietary CPM engine depth or forensic delay analysis as purpose-built analytics platforms

DCMA+ scoring system provides accessible quality benchmarking

Native integrations with Procore, Autodesk, or Egnyte are not prominently advertised in publicly available documentation at time of writing

Tiered pricing for individuals through enterprise

Professional reporting is an add-on rather than included in base tiers

Free Essentials tier + 30-day professional trial available

Reviews

We could not find any publicly available reviews for Schedule Validator.

5. Oracle Primavera P6 - CPM Schedule Development and Management

Oracel Primavera Homepage

Oracle Primavera P6 is the industry standard for CPM schedule creation on complex construction projects. It has anchored the scheduling workflow on major programs - hospitals, federal facilities, infrastructure, data centers - for decades.

It is the tool where schedules are built, not where they are analyzed. P6 is the foundation layer of the project controls stack, and what comes out of it feeds the analytics tools that deliver actual performance insight.

Best For: ENR-level GCs, construction managers, and owner organizations managing large, complex construction projects that require rigorous CPM schedule development, resource loading, and baseline management. P6 is most effective in the hands of classically trained schedulers - it is not a general-purpose project management software tool.

Our Score: 60 / 100

Note: P6's score reflects its performance against project controls analytics criteria - not its value as a scheduling tool, which is best in class. Evaluating P6 against schedule analytics criteria is like scoring a diagnostic tool on its ability to build schedules.

Criteria

Score

Schedule Quality Analysis

8/20

Analytical Engine & Data Integrity

13/15

Delay Analysis & Forensic Capabilities

8/15

Portfolio Visibility & Reporting

6/10

Integration Ecosystem

9/10

Ease of Adoption & Time to Value

4/10

Security, Compliance & Data Governance

7/10

Value & Pricing Transparency

5/10

Total

60/100

Key Features

  • CPM Schedule Development: Handles projects up to 100,000 activities with unlimited target plans and resources
  • Baseline Management: Establishes and tracks multiple baselines through the project lifecycle
  • Resource Allocation: Allocates, tracks, and optimizes labor, equipment, and materials across projects
  • Portfolio Management (EPPM): The enterprise version provides portfolio-level visibility and role-based dashboards
  • Risk Analysis Integration: Integrated risk tools for identifying and evaluating schedule threats
  • P6 Professional: Windows desktop client for standalone schedule development
  • Oracle Primavera Cloud: Fully re-engineered cloud SaaS version with integrated CPM and lean scheduling

The Project Controls Impact

P6 does one thing better than any other tool: it builds schedules that hold up. On major commercial, healthcare, infrastructure, and federal construction projects where the owner demands a logic-driven, resource-loaded baseline schedule that meets contractual requirements, P6 is almost universally expected.

P6 is a schedule creation tool. Critical path calculation is built in, but schedule quality grading, performance measurement across updates, narrative reporting, and forensic delay analysis are not - those functions require manual work from P6 exports alone.

For organizations that need that analytical layer, SmartPM connects directly with P6, processing the schedule data it produces through a proprietary CPM engine to deliver automated quality checks, performance tracking, and defensible delay analysis. SmartPM can even export custom-built models into .xer formats. The two tools are designed to work together: P6 builds the schedule, SmartPM tells you what it means.

Integrations

Oracle Primavera Cloud, Oracle Unifier, Primavera Gateway, and third-party tools via API. P6 Professional has more limited native integration capability than the EPPM and Cloud versions.

Pricing

P6 Professional is available as a perpetual license starting around $2,500, plus annual support fees. Oracle Primavera Cloud starts around $100/user/month based on historically published pricing. Contact Oracle directly for current quotes.

Pros and Cons

Pros

Cons

The industry standard for CPM schedule development on complex projects

Steep learning curve; effective use requires trained schedulers

Handles extreme schedule complexity - up to 100,000 activities

Primarily a schedule creation tool - performance analytics require manual work or add-on platforms

Widely understood by schedulers, owners, and subcontractors

Based on publicly available documentation, does not appear to advertise automated schedule quality grading or forensic delay analysis comparable to purpose-built analytics tools

Multiple deployment options (desktop, enterprise web, cloud)

Licensing and implementation costs can be significant for smaller organizations

Reviews

Capterra: 4.4 stars out of 5 - 179 ratings

One review saysI like primavera for planning. Many construction contracts and government bids require primavera planning as a mandatory planning tool for monthly report sharing, however, it is not easy to use or learn.”

6. Steelray Project Analyzer - Desktop Schedule Quality Analysis

Steelray Project Analyzer

Steelray Project Analyzer has built a durable reputation among schedulers who work primarily in Microsoft Project. Based on publicly available documentation, it runs as a Windows desktop application with primary support for MS Project files, with P6 also supported.

It includes a built-in knowledge base called "The Coach" that explains quality findings and teaches scheduling best practices - a feature that makes it particularly useful for practitioners developing their scheduling skills rather than just running compliance checks.

Best For: Individual schedulers and project controls practitioners who need rigorous MS Project schedule quality analysis, DCMA 14-point compliance checking, and detailed diagnostic reporting. Organizations that work extensively in Microsoft Project and need a reliable, low-overhead quality analysis tool before submitting schedules for owner review or formal audit.

Our Score: 55 / 100

Criteria

Score

Schedule Quality Analysis

14/20

Analytical Engine & Data Integrity

9/15

Delay Analysis & Forensic Capabilities

6/15

Portfolio Visibility & Reporting

4/10

Integration Ecosystem

4/10

Ease of Adoption & Time to Value

8/10

Security, Compliance & Data Governance

4/10

Value & Pricing Transparency

6/10

Total

55/100

Key Features

  • DCMA 14-Point Assessment: Built-in compliance checking with results explained in plain language
  • Statistically Validated Scorecards: Proprietary scoring methodology based on a large community of project managers across industries
  • The Coach: Built-in encyclopedia explaining quality findings and the reasoning behind each flag
  • Schedule Comparison Reports: Visual comparison of two schedules showing changes between versions
  • Microsoft Office Output: Reports export directly to Excel, Word, and PowerPoint
  • Hyperlink Navigation: Click directly to flagged activities in Microsoft Project from within the report

The Project Controls Impact

Steelray does one thing consistently well: it finds problems in Microsoft Project schedules that teams could otherwise miss. The DCMA assessment, combined with statistically validated criteria built from thousands of schedules, surfaces logic errors, inappropriate constraints, and critical path reliability issues that make schedules misleading even when they look complete.

The architectural difference from SmartPM is direct and worth stating plainly. Steelray is a Windows desktop application designed for single-project analysis by an individual practitioner. SmartPM is a cloud-native platform designed to run schedule analytics across an entire portfolio for teams and organizations.

Based on publicly available documentation, Steelray does not appear to advertise portfolio dashboard capability, direct integrations with Procore or Autodesk, or the forensic delay analysis depth of enterprise project controls platforms.

Integrations

Steelray Project Analyzer primarily supports Microsoft Project .mpp files, with Primavera P6 and UN/CEFACT XML also supported. Reports export to Microsoft Excel, Word, and PowerPoint.

Pricing

Steelray Project Analyzer is available as a licensed desktop application. A trial version is available. Contact Steelray directly for current pricing.

Pros and Cons

Pros

Cons

Well-established reputation for MS Project schedule quality analysis

Desktop application - does not appear to offer cloud-based access based on publicly available documentation

DCMA 14-point assessment with plain-language explanations

Portfolio-level management capability is not prominently advertised

"The Coach" adds genuine educational value for developing schedulers

Native integrations with Procore, Autodesk, or CMiC are not prominently advertised at time of writing

Direct hyperlink navigation to flagged activities in MS Project

Primarily designed for MS Project users; P6-heavy organizations may find it less suited to their primary workflow

Reviews

We could not find any publicly available reviews for SteelRay Analyzer.

7. ALICE Technologies - AI-Driven Generative Scheduling and Optimization

Alice Homepage

ALICE Technologies is a preconstruction planning tool that uses AI to generate and test schedule scenarios before construction begins. Rather than analyzing a schedule that already exists, it builds and simulates alternatives - modeling different crew configurations, sequences, and resource allocations to identify a more efficient build plan prior to breaking ground.

Rather than analyzing a schedule that already exists, ALICE builds and tests schedules - simulating millions of construction project scenarios to identify optimal build sequences, resource allocation, and durations before the project starts. It answers "what is the most efficient way to build this?" rather than "how is this project performing against plan?"

Best For: Contractors and owners focused on optimizing construction schedules during preconstruction, bidding, and planning - where testing build sequence scenarios, modeling resource constraints, and identifying the most efficient delivery strategy before breaking ground can materially affect project outcomes.

ALICE is purpose-built for the planning phase. Organizations evaluating it for execution monitoring are working against the grain of what the platform is designed to do.

Our Score: 50 / 100

Note: ALICE is included in this review because construction project controls teams will encounter it in vendor conversations and RFP responses, and understanding where it fits - and where it does not - is useful context. It is a preconstruction optimization platform, not a schedule analytics tool. Its score reflects performance against project controls analytics criteria by design: the low number is not a quality judgment on ALICE, it is a signal that it operates in a different domain. If your primary need is optimizing build sequences before breaking ground, ALICE belongs in a separate evaluation entirely.

Criteria

Score

Schedule Analytics Depth

14/20

Schedule Quality & Compliance

8/20

Portfolio & Visibility

9/15

Integration Ecosystem

8/15

Forensic / Delay Analysis

3/15

Ease of Use & Deployment

6/10

Value & Transparency

2/5

Key Features

  • Generative Scheduling: Simulates millions of construction scenarios using AI algorithms to identify optimal build sequences
  • What-If Scenario Analysis: Modify project parameters and immediately see the impact on schedule, cost, and resources
  • Resource Optimization: Models labor, equipment, and material constraints to minimize idle time and maximize efficiency
  • BIM Integration: 4D construction simulation for BIM-based projects
  • DCMA 14-Point Check: Schedule quality checking built in

The Project Controls Impact

ALICE addresses a different - and genuinely valuable - problem: the fact that most construction schedules are built using the same sequence the last project used, without systematically testing whether a different approach would be faster, cheaper, or less risky. For contractors who take preconstruction seriously, the ability to simulate millions of build scenarios before committing to a baseline has a real impact on project success.

ALICE has published customer performance data including a 17% reduction in project duration and 14% reduction in labor costs on programs where the platform was applied. These are figures ALICE has reported from their customer cases and should be evaluated accordingly. Where SmartPM and ALICE can coexist within the same program: ALICE optimizes the schedule before construction begins, SmartPM monitors actual performance against that baseline throughout the project lifecycle.

Integrations

Based on publicly available documentation, ALICE integrates with BIM tools for 4D simulation. Contact ALICE directly for current integration documentation and supported file formats.

Pricing

ALICE Technologies does not publicly list pricing. Contact ALICE directly for current pricing.

Pros and Cons

Pros

Cons

Genuinely different approach - generative AI schedule optimization rather than diagnostics

Purpose-built for preconstruction - based on publicly available documentation, does not appear to be primarily designed for execution monitoring or ongoing performance measurement

Addresses a real gap in how most projects are planned (sequence assumption vs. scenario testing)

Based on publicly available documentation, does not appear to advertise the forensic delay analysis depth of purpose-built analytics platforms

BIM integration for 4D simulation

Integration ecosystem appears more limited than established project controls platforms at time of writing

Strongest tool in this review for preconstruction phase optimization

Reviews/Case Studies

Norwegian developer AF Gruppen used ALICE on a nine-building midrise residential project in Oslo valued at approximately $560 million. Their original schedule, built in Touchplan over four months, projected a 500-day build. In four days, the team used ALICE to generate more than 300 alternative schedules, seven of which outperformed the original plan.

The optimized schedule came in at 396 days - an 18% reduction in project duration - achieved by modeling different crew configurations and switching from standard to reusable formwork. AF Gruppen also reduced overall project costs by 15% through the sequencing and resource changes ALICE identified.

What is Construction Project Controls?

Construction project management and construction project controls are related but distinct disciplines. Construction management coordinates the work: who does what, when, and in what sequence. Project controls measures whether the work is proceeding as planned - and quantifies the gap when it is not. It is a professional discipline with established methodologies, industry standards, and measurable outcomes, not simply a software category.

Think of it this way: a project controller tells everyone, with data, how the project is actually running. That distinction matters enormously when project budgets are on the line and successful project delivery is expected by the owner.

At its core, project controls answers three questions on a continuous basis:

  • Is the schedule reliable? Does the baseline reflect how the project will actually be built, and is the current update an honest picture of where things stand?
  • Is performance on track? How does actual progress compare to planned progress, and where is the critical path being compressed or extended?
  • When are problems going to become expensive? Are potential risks visible early enough to act on them, or only after delay has been built in?

Organizations with strong project controls programs catch problems when they are still correctable. Organizations without them discover problems when they are already expensive. That gap - between early visibility and late awareness - is where margin lives or disappears.

This is why project controls help general contractors protect both project integrity and margin across their portfolio, and why the construction industry increasingly treats project controls as a core operating discipline rather than a compliance exercise.

The Three Core Components of Construction Project Controls

Project controls is not a single activity. It is a set of interconnected functions that operate together throughout the project lifecycle. Three key components form the foundation of every effective program.

1. Schedule Quality and Baseline Management

Everything in project controls starts with the schedule. A schedule that is logically flawed, over-constrained, or built without realistic durations is not a management tool - it is a liability. If the baseline does not reflect how the project will actually be built, every subsequent performance measurement is weighing against a fiction.

Schedule quality management involves checking CPM schedules against recognized standards - the DCMA 14-point assessment is the most widely used benchmark - to verify that the logic is sound, constraints are appropriate, float is realistic, and the critical path is trustworthy. Per DCMA guidance, this work should happen before a baseline is approved, not after delays have already occurred.

What to track:

  • Logic errors: open ends, redundant relationships, circular logic, inappropriate use of leads and lags
  • Constraint overuse: hardcoded dates that prevent the schedule from calculating a realistic critical path
  • Float distribution: near-zero total float across the network is a signal of over-constraint, not schedule tightness
  • Task dependencies: activity counts and durations inconsistent with project scope and complexity
  • Baseline feasibility: whether the schedule, as built, is physically buildable in the sequence and timeframe shown

The practical implication: a schedule that passes quality checks is not guaranteed to finish on time, only that the data inside is worthy of analysis. But a schedule that fails them is almost certainly not telling the truth about when the project will finish.

2. Performance Measurement and Progress Monitoring

Once a quality baseline exists, project controls measures actual performance against it - systematically, at regular intervals, across every update cycle. This is where effective project controls earns its value in active construction project management.

Performance measurement compares planned progress to actual progress, calculates Schedule Performance Index (SPI) values, identifies which activities are driving delay, and quantifies how much the completion date has moved since the last update. Done manually, this analysis takes days. Done with the right management software, it happens in minutes. This is what allows resource management and project execution decisions to be made on current data rather than last month's snapshot.

What to track:

  • Project progress vs. planned: at the activity, work package, and project level
  • Schedule Performance Index (SPI): the ratio of earned value to planned value - below 1.0 means the project is behind plan
  • Critical path changes: which activities shifted onto or off the critical path between updates, and why
  • Compression ratios: how much remaining work is being compressed into the available float
  • Milestone displacement: how far key milestones have moved from their baseline dates over time

The frequency of this analysis matters as much as the depth. Monthly analysis means problems identified in week two of a four-week period have already been compounding for three weeks before anyone sees them. Weekly analysis - made practical by automated analytics - means corrective action happens while there is still float left to spend.

This cadence is what separates proactive construction management from reactive damage control. It is also when risk management shifts from a plan document to a live operational function.

3. Delay Analysis and Forensic Documentation

Even well-run projects encounter delay. What separates organizations that manage delay professionally from those that end up in disputes is the quality of the documentation trail and the rigor of the analysis methodology.

Forensic delay analysis quantifies the causes, timing, and responsibility for delays using the schedule update history as the evidentiary foundation. A defensible delay analysis requires a complete record of every schedule update, a reliable calculation methodology, and a platform that processes that data through a real CPM engine rather than manual comparison.

Strong document management discipline is not optional here - it is the foundation. Without it, scope creep, owner-caused delay, and contractor-caused delay become impossible to separate with confidence, and risk management turns reactive instead of proactive.

What to track:

  • Owner-caused delay: changes in scope, late owner-furnished information, differing site conditions
  • Contractor-caused delay: productivity shortfalls, resource gaps, sequencing errors
  • Excusable delay: weather events, force majeure, documented impacts outside the contractor's control
  • Concurrent delay: overlapping owner and contractor delays that affect the same critical path activities
  • Schedule update audit trail: a complete, timestamped record of every baseline and update from project start through completion

Organizations that treat their project controls data as potential litigation documentation from day one spend significantly less time and money resolving disputes than those that reconstruct the record after the fact.

The schedule update history is the most important document in any construction claim. Project controls help most when this discipline is built in from the start, not bolted on after a dispute arises.

Key Features to Look for in Construction Project Controls Software

Not all project controls software is built the same way.

The features that separate platforms capable of supporting serious construction project management from those that check a reporting box are specific and worth understanding before making a purchasing decision.

Feature Category

Why It Matters

What to Look For

Analytical Engine

Determines whether the platform calculates or merely displays

Proprietary CPM engine, not a BI visualization layer

Schedule Quality Grading

Baseline reliability drives all downstream project performance

DCMA 14-point check plus proprietary metrics; automated scoring

Performance Monitoring

Catching delay early is the difference between correctable and expensive

SPI trending, critical path shift detection, milestone displacement tracking

Forensic Delay Analysis

Every project has delay; not every team can prove what caused it

Audit trail from baseline through closeout; defensible methodology

Portfolio Visibility

Single-project analysis misses organizational risk patterns

Real-time portfolio dashboard with drill-down to project and activity level

Integration Ecosystem

Standalone tools create manual work and data gaps

Native connections to P6, Procore, Autodesk, Egnyte; not CSV exports

Automated Reporting

Manual report assembly consumes analyst time better spent on analysis

Owner-ready reports generated automatically on schedule upload

Scalability

Tools that work for five projects must work for fifty

Unlimited project capacity; no per-project pricing that penalizes growth

The Feature That Separates the Field: The Analytical Engine

Every other feature in the list above depends on this one. A proprietary CPM engine processes schedule data mathematically - running activity relationships, calculating float, quantifying delay, and detecting logic errors through its own computation. A visualization or reporting layer takes whatever data is fed to it and presents it. The difference is not cosmetic. It is the difference between analysis you can defend and a dashboard that shows you what you already put in.

Power BI and Tableau are visualization tools. They display data. They do not calculate schedule health. A project control systems platform built on a real CPM engine does the math first and then presents the output. When the analysis needs to hold up in an owner review, a change order negotiation, or a formal dispute, that distinction determines whether your data is defensible or decorative.

Analyze Construction Schedule Quality with Ease

How to Build a Construction Project Controls Program That Actually Works

A project control systems program is not software. It is a set of processes, disciplines, and standards that software supports. Organizations that buy a platform without building the process around it get expensive dashboards.

Organizations that build the process and then automate it with the right platform achieve successful construction projects consistently - ones that protect project timelines, stay within budget, and support sound decision making at every level of the organization.

Establish Schedule Quality Standards Before a Project Starts

Document what a quality baseline looks like before the first project uploads - minimum activity count thresholds, maximum duration limits, float thresholds, constraint rules, and DCMA compliance requirements - and record these as part of your project plans.

The baseline review process - who checks it, against what criteria, and what happens when a schedule fails - should be established before it becomes urgent. Most organizations learn these standards reactively, after a schedule causes a problem. The ones that build them proactively spend significantly less time and money on remediation.

Set a Regular Update Cadence and Stick to It

Monthly schedule updates are the industry default - and one of the most reliable ways to ensure delay is discovered too late to correct. The organizations with the strongest controls programs update weekly or bi-weekly, not because they have more staff, but because automated analytics make weekly tracking progress practical. When analysis takes minutes instead of days, the cadence question becomes easy to answer.

Build Reporting That Non-Specialists Can Actually Use

Project controls data is only valuable if the people who need to act on it can understand it. Effective programs build tiered reporting: a one-page executive summary for leadership, a project-level report for the PM and superintendent, and detailed diagnostic output for the project controls specialist. Each layer supports better decision making at the right level of detail.

Track the Schedule Across the Portfolio, Not Just Per Project

Individual project analysis tells you whether a single project is on track. Portfolio-level analysis tells you which projects are at risk and which patterns are showing up across jobs that no single PM can see. A VP of Operations managing fifteen projects needs a single dashboard, not fifteen separate reports. Portfolio visibility is the step that turns project controls from a project-level function into an organizational capability.

Treat the Schedule Update History as a Legal Document

Every schedule update is a data point in the delay story of the project. Organizations that maintain a complete, timestamped, unaltered record of every baseline and update from project start through project closure have the evidentiary foundation to support any claim that arises. Store everything. Date stamp everything. Never overwrite a submitted update.

Start Where You Are - Then Build

Not every organization is ready for forensic delay analysis and portfolio-level SPI tracking on day one. A mid-market GC that has never done structured schedule analytics is better served by starting with a quality baseline review process and a simple health dashboard than by attempting to implement a full enterprise controls program in one step.

Build the foundation first: schedule quality, then performance monitoring, then forensic capability. Better yet, partner with a software that will accompany you on your project controls journey by finding out where your weaknesses lie, helping generate SOPs and schedule specs, and automating reports that everyone can understand.

Why Project Controls Matters More Than Most GCs Realize

Construction operates on margins too thin to absorb the cost of being surprised. Average net margins in commercial construction run between 2% and 5%. A single project that finishes 10% over schedule - on a $20 million job - can eliminate the profit from two or three other projects in the same portfolio.

Understanding this is why project controls important is not a theoretical question: it is an arithmetic one.

The Cost of Late Visibility

When schedule analysis happens monthly, delay identified in week two of a reporting period has already been accumulating for weeks before anyone sees it. Resources have been committed. Subcontractors have mobilized against a sequence that no longer holds. Float that could have been managed has been consumed.

A delay caught in week one, with three weeks of float remaining, is a scheduling problem. A delay caught in month three, after float is exhausted and the critical path has shifted, is a financial problem - one that directly affects project progress and the ability to finish within budget. The difference between those two outcomes is the frequency and quality of schedule analysis, not the severity of the underlying issue.

The Hidden Cost of Poor Schedule Quality

Most organizations focus on schedule performance - how are we tracking against plan? Fewer focus on quality control of the plan itself - is it worth tracking against? A schedule with 40% open-end logic errors, excessive constraints, and inflated float does not produce reliable performance metrics. It produces numbers that look fine on a dashboard while the construction project slides.

Schedule quality is the foundation that makes performance measurement meaningful. Without it, the entire controls program is measuring against a benchmark that cannot be trusted.

The DCMA 14-point check exists because this problem is universal - government agencies mandated objective quality standards precisely because schedule manipulation, whether intentional or the result of poor practice, is pervasive enough to require standardized measurement. Key performance indicators mean nothing when derived from a flawed baseline.

The Claims and Disputes Multiplier

The most expensive project controls failure is not a delayed project. It is a delayed project with no defensible record of what caused the delay, when it occurred, and who was responsible.

Cost overruns from construction litigation are driven by this documentation gap more than by the underlying facts of the dispute. Claims that could have been resolved through schedule data become expensive because the data does not exist, was not maintained properly, or cannot be analyzed in a defensible way.

Organizations with strong project controls programs - complete update histories, quality-graded baselines, regular performance documentation - resolve disputes faster and at lower cost. The investment in controls infrastructure pays its clearest dividend in the claims that never become litigation.

See how SmartPM gives your team the schedule visibility that prevents these problems. Book a demo.

How to Strengthen Your Construction Project Controls Program

Most organizations already have some version of project controls in place. The question is whether their construction project management processes are rigorous enough to catch problems early, consistent enough to produce comparable data across projects, and automated enough to streamline operations without a large dedicated team.

Audit Your Current Schedule Quality Baseline

Before improving performance measurement, assess whether the baselines being measured against are trustworthy. Run your current active project schedules through a DCMA 14-point style check. Better yet, partner with organizations that will help you build custom quality profiles according to your projects. Look at open ends, constraint counts, near-critical float distribution, and activity density relative to project scope.

Most organizations that do this for the first time discover that a meaningful percentage of their baselines have quality issues that have never been flagged. That is not a failure - it is a starting point.

Move From Monthly to Weekly Analysis

If your organization does monthly schedule updates, the single highest-impact change is increasing that frequency. Manual analysis that takes days per project cannot scale to weekly without more staff.

The solution is automation: a platform that converts a schedule upload into a complete performance report in minutes removes the time constraint. Catching a critical path shift in week two versus week five of a reporting period can mean the difference between a recovery plan and a delay notice.

Standardize Across Your Construction Teams

One of the most common and costly controls failures is inconsistency: each project team uses different scheduling conventions, different quality thresholds, and different reporting formats. The result is a portfolio where no meaningful cross-project comparison is possible.

Standardizing on a common schedule structure, common quality criteria, and common reporting format across all projects is what makes portfolio-level analysis meaningful.

Connect Your Controls Stack

Project controls data that lives in a silo creates manual reconciliation work. The most effective controls programs build a connected stack: P6 or MS Project for schedule development, a dedicated analytics platform that pulls schedule data automatically, and a reporting layer that distributes output to the right audiences without manual assembly. Every manual step in that chain is a point where data gets delayed, altered, or lost.

Invest in Controls Capability, Not Just Controls Software

Software does not run a project controls program. People do. The organizations with the strongest programs invest in training their project controls staff on methodology - CPM logic, delay analysis principles, performance measurement techniques - not just on how to use the software. The software accelerates and scales the capability. The capability itself has to be built.

Challenges in Construction Project Controls - and How to Address Them

Every organization that has tried to implement project controls seriously has encountered the same obstacles. Understanding them in advance does not eliminate them, but it does prevent the kind of surprise that derails implementation.

Challenge 1: Schedule Quality Variability Across Projects and Teams

Inconsistent schedule quality is the most fundamental controls challenge, and it compounds every downstream problem. When some project team members produce rigorous, logic-driven CPM schedules and others produce constraint-heavy, loosely connected activity lists, portfolio-level performance comparison becomes meaningless.

The Solution: Automated schedule quality grading applied consistently at baseline submission - before the project begins, not after the first update cycle. When every baseline is checked against the same DCMA-based criteria and scored objectively, the conversation about schedule quality becomes data-driven.

Schedulers know exactly what the standard is. Project managers know exactly what they are signing off on.

Challenge 2: Analysis Takes Too Long to Be Actionable

The most common reason project controls programs fail to catch delay early is not that the data is unavailable - it is that processing it manually takes long enough that by the time analysis is complete, the window for correction has closed. A project controls analyst spending three days per project on monthly schedule reviews is not doing project controls. They are doing historical documentation.

The Solution: Automation that converts a schedule upload into a complete performance report in minutes, not days. When the analytical work is handled by a platform with a real CPM engine, the analyst's time shifts from calculation to interpretation - from assembling the numbers to understanding what they mean and acting on them.

That shift is what makes weekly analysis sustainable without adding headcount and what enables genuinely informed decisions at the project and portfolio level.

Challenge 3: No Portfolio Visibility Across Active Projects

Most project management tools are built around the single-project view. The person responsible for the performance of the entire portfolio - a VP of Operations, a Director of Project Controls, a COO - has to aggregate information from many different sources - usually into Excel - to understand what is happening across the organization. That aggregation process is slow, manual, and only as accurate as the least reliable report in the stack.

The Solution: A dedicated analytics platform with a portfolio dashboard that pulls schedule data from all active projects simultaneously and presents unified health indicators, risk flags, and performance trends in a single view.

The goal is to make the transition from portfolio view to project drill-down instantaneous, so leadership can identify which future projects and current projects need attention without waiting for a meeting or a weekly report.

Challenge 4: Resistance from Project Teams Who See Controls as Overhead

Project controls programs fail for organizational reasons as often as technical ones. When field teams and construction project managers view schedule analysis as a reporting burden rather than a management tool, compliance drops, update quality deteriorates, and the data the controls function depends on becomes unreliable. This is especially common when controls processes add administrative work without adding visible value to the people doing the work.

The Solution: Make the output of the controls process visibly useful to the project team. When a project manager uploads a schedule update and immediately receives a performance report that tells them where their critical path has shifted, which activities are driving delay, and what their current completion forecast looks like - that is a management tool, not an administrative burden.

The adoption problem largely solves itself when project stakeholders see the controls process return something useful to them, not just to the executive dashboard.

Challenge 5: Data That Cannot Support a Claim

When disputes arise - and on enough projects, they will - the quality of the schedule data is often the deciding factor in how quickly and favorably the dispute resolves. Organizations that cannot produce a clean audit trail from baseline through the disputed period are starting from a significant disadvantage.

The Solution: Treat every schedule update as a permanent record from the moment the project starts. A platform with a real CPM engine that stores every update, timestamps every comparison, and produces forensic-grade delay analysis from that complete history is the basic infrastructure that makes dispute resolution manageable.

Build contingency plans around the assumption that dispute documentation will eventually be needed. The cost of building that record is negligible compared to the cost of reconstructing it when a claim surfaces.

What Are the Key Factors for Choosing a Project Controls Solution for Construction?

The most important factors for choosing a construction project management controls solution are the ones that map to the specific problem your organization is trying to solve - not a generic feature checklist. Here are six questions that separate a good evaluation from a vendor tour.

Does the tool have a real analytical engine, or is it a reporting layer?

This is the question most organizations do not think to ask. Many platforms take schedule data and present it visually - they do not perform the underlying CPM calculations. The difference matters when the analysis needs to stand up in an owner review, a dispute, or a formal delay claim.

A proprietary CPM engine processes the schedule mathematically; a visualization layer displays what is fed to it. Know which one you are buying, because the downstream impact on project performance is significant.

Which stage of the project lifecycle does it actually serve?

Preconstruction optimization (ALICE), execution monitoring (SmartPM), cost and EVM management (InEight), and schedule creation (P6) are all project controls activities - but they belong at different points in the project. Selecting a planning tool for an execution problem means buying the right tool for the wrong job.

Does it check schedule quality against DCMA and industry standards?

The DCMA 14-point schedule assessment has become the practical benchmark for CPM schedule quality in construction, particularly on public and government projects. Any tool being considered for serious project controls work should address these checks as part of its quality control processes.

Can it support forensic delay analysis if a claim arises?

Most organizations do not budget for claims during a project. Most projects encounter some form of disputed delay. The ability to produce defensible, audit-ready analysis - showing exactly what happened, when, and why, with a traceable methodology - is a significant differentiator. This is a critical component of any platform evaluated for serious project controls work.

Does it integrate with your existing stack without replacing it?

The best project controls programs do not rip out existing tools - they layer analytics on top of them. Confirm that any analytics platform you evaluate connects cleanly with your scheduling tool (P6, MS Project), your project management platform (Procore, Autodesk), and your reporting environment.

Does it scale to portfolio-level visibility?

For GCs managing multiple active projects, single-project analysis is only half the picture. The ability to see schedule health, risk distribution, and performance trends across the entire portfolio - with one click - is what moves project controls from a project-level function to an organizational capability and enables genuinely informed decisions and faster decision making at the executive level.

Without portfolio visibility, decision making at the top defaults to whoever gave the most recent verbal update.

Which Construction Project Control Tool Is Right for Your Organization?

The right tool depends almost entirely on where your organization sits in terms of project type, controls maturity, and the specific problem you are trying to solve. Here is a practical framework for decision making. Getting this right is one of the most consequential decisions a construction project management team can make.

ENR Top 100 GC with a mature project controls team: P6 for schedule development + SmartPM Controls as the analytics and forensic layer. Portfolio dashboard across all active projects, automated quality reporting, and forensic-grade delay analysis when claims arise. This is the combination that reflects how leading firms actually operate and how they deliver successful construction projects at scale.

Mid-market GC building a controls function from the ground up: SmartPM Essentials is designed for this. Flat annual pricing, unlimited projects, simplified dashboards with color-coded health indicators, and the ability to grow into more sophisticated controls as the organization matures.

It gives teams that have never done schedule analytics a place to start without drowning in complexity and helps them protect project timelines, stay within budget, and build the informed decisions capability that grows with the organization.

Owner or developer managing contractor-delivered programs: SmartPM gives owners and developers independent, data-driven visibility into contractor schedule performance without relying solely on contractor-produced reports. Columbia Ventures described using SmartPM to "remove emotion" from negotiations by anchoring discussions in factual schedule data. That is risk mitigation strategies made practical.

Federal agency or government program office: FedRAMP High authorization is a non-negotiable for most federal data environments. SmartPM is one of very few construction analytics platforms to hold this authorization. For government-funded construction programs, that compliance posture simplifies procurement and security review considerably.

Large capital construction program (infrastructure, industrial, power): InEight's cost/EVM/schedule integration may be appropriate here, particularly when cost control and earned value reporting are as important as schedule analytics.

Individual scheduler focused on MS Project quality: Steelray Project Analyzer is a well-regarded desktop tool for this specific use case.

See how general contractors use SmartPM to manage project performance at every stage of the project lifecycle.

Ready to see what SmartPM looks like in your environment? Book a personalized demo.

Do These Tools Work Together, or Do You Have to Pick One?

The short answer: the best project controls programs layer multiple tools, and that is by design. Most of the platforms reviewed here are not substitutes for each other - they are complements that serve different parts of the workflow.

The most common and effective stack for commercial GCs looks like this: P6 or MS Project for schedule creation. SmartPM as the analytics layer that processes schedule updates and delivers automated performance reporting, quality checks, and predictive delay analysis. Procore, Autodesk, or another project management software platform for document management, RFIs, submittals, and field coordination. SmartPM integrates with all of them - it does not require replacing any of them.

This is an important distinction. Adding SmartPM does not mean ripping out P6. It means making P6 more useful - because the schedule data that P6 produces now flows into an analytics engine that tells you what it means.

The same is true with Procore and Autodesk integrations: SmartPM pulls the schedule data that already lives in those platforms and runs it through its CPM engine. Document management, RFI workflows, and field coordination stay in their existing platforms.

SmartPM adds the analytical layer on top. This is what integrating project controls into an existing construction stack actually looks like in practice.

Layton Construction put it well: SmartPM provides "almost limitless insights you can extract from the schedule." That is not possible when the schedule lives in a creation tool and analysis happens manually in Excel.

Review real results from contractors using SmartPM across sectors including commercial, healthcare, data centers, and federal programs.

Frequently Asked Questions

Detailed Scoring Breakdown

Disclosure: SmartPM is the publisher of this methodology. We evaluated our own product using the same criteria applied to every other tool in this review. We encourage readers to verify capabilities through a demo and direct customer references.

The Bottom Line: Match the Tool to the Problem

The construction project management software category is not monolithic, and the best organizations in the construction industry stopped treating it that way years ago. P6 builds the schedule. SmartPM analyzes it. InEight manages cost and earned value at capital scale. ALICE optimizes before construction starts. Steelray and Schedule Validator provide quality checking for specific practitioner workflows.

Each has a place in the landscape. And as construction project management matures across the construction industry, organizations that use these tools strategically will continue to outperform those that treat them interchangeably.

The mistake to avoid is treating any single tool as a complete project controls solution. The GCs that have built genuinely strong controls programs - the ones that catch delay early, protect margin, finish within budget, and produce defensible reporting when disputes arise - use a layered stack. And at the center of that stack is an analytics engine that actually does the math on their schedule data, not one that just presents it.

More than half of the ENR Top 50 have chosen SmartPM as that analytics layer. The reason is straightforward: it was built by someone who spent two decades doing forensic delay analysis on construction projects, and it shows in the depth of what the platform can surface from a schedule.

The key benefits are not features on a spec sheet - they are outcomes that show up in project performance, margin protection, and disputes that never reach litigation. When project plans are grounded in reliable data and project deliverables are tracked against defensible baselines, the organization runs better at every level.

Explore automated schedule quality and performance analytics with SmartPM Controls to see what a real CPM engine looks like in practice.

See SmartPM in your environment. Book a demo with the SmartPM team.

Information accurate as of March 2026. All competitor capability descriptions are based on publicly available documentation at time of writing and have not been independently verified. Feature sets and pricing may have changed since publication.

Previous Post: How We Review Construction Schedule Analytics Software

How We Review Construction Schedule Analytics Software

Related Stories
