What Float in CPM Schedules Means for Your Construction Project

In essence, float can offer a buffer against unexpected changes, allowing activities to be postponed without impacting the overall end date.

Understanding the concept of float in CPM scheduling is foundational to achieving data-driven project controls. Float, also known as “slack,” is the amount of time an activity can be delayed without impacting the project’s end date. More importantly, float is one of the primary indicators of end date confidence. When float is consumed, compressed, or artificially inflated, the reliability of the finish date changes - even if the date itself does not move.

Table of Contents

Types of Float in CPM Construction Schedules

Float is not something to trust blindly. It is a byproduct of schedule logic. When logic is incomplete, float expands artificially. When execution slips, float erodes. Understanding float is less about finding buffer and more about understanding how much risk exists in the schedule.

1. Total Float: Total float is the amount of time an activity can be delayed without pushing back the overall project completion date. It is the broadest measure of schedule flexibility and the primary metric used to identify the critical path - activities with zero total float are, by definition, driving the project's finish date.

Total float is calculated by subtracting an activity's early finish date from its late finish date. When that number is zero, there is no room for delay. When it is positive, the activity has some breathing room - but that breathing room is not unlimited or guaranteed.

A few things total float does not tell you:

  • It does not mean the activity is unimportant. An activity with 20 days of total float can still become critical if a predecessor slips, logic changes, or float gets consumed elsewhere in the network.
  • It does not mean that float is exclusively yours to use. On paths where multiple activities share the same float pool, one activity consuming float reduces what is available to every other activity on that path.
  • It does not account for resource constraints. A scheduler may show total float on paper, but if the crew needed for that activity is already committed elsewhere, the float is not practically usable.

For project controls purposes, total float is most useful as a portfolio-level signal - it tells you at a glance which activities are critical, which are near-critical, and which have genuine flexibility. The risk is treating high total float as a sign that an activity requires no attention. Float can erode quickly, and by the time an activity with 30 days of float becomes critical, the window to act may already be closing.

Total float is also a shared project resource. When multiple activities sit on the same path, they draw from the same float pool. One delay consumes float for every downstream activity — which is why float should be treated as project risk capacity, not individual task flexibility.

2. Free Float: Free float is the amount of time an activity can be delayed without affecting the early start of any immediate successor. It is a more localized measure than total float - instead of measuring impact on the project end date, it measures impact on the next activity in sequence.

An activity can have significant total float but zero free float. This means the activity has room to slip without affecting the project's completion date, but any slip at all will immediately push back the activity that follows it. In a multi-trade environment, this distinction matters. A delay in one trade's activity may not show up on the project end date for weeks - but it can block the next trade from starting on time the very next day.

Free float is particularly valuable for identifying trade handoff risk. An activity with zero free float means any slip immediately impacts the next trade – even if total float still exists at the project level. Free float is also useful for:

  • Subcontractor / Trade Partner coordination: Knowing which activities have free float tells you which trades can absorb a short delay without creating an immediate chain reaction. Knowing which have zero free float tells you which handoffs need to be protected at all costs.
  • Short-interval scheduling: When building look-ahead schedules for the next two to four weeks, free float is more actionable than total float because it reflects immediate sequencing impact rather than end-date impact.
  • Identifying logic gaps: An unusually high free float value on an activity that should logically connect to the next phase of work is often a signal that a successor relationship is missing from the schedule.

The practical difference between total float and free float comes down to this: total float tells you how much time you have before the project is affected, and free float tells you how much time you have before the next activity is affected. Both numbers matter - but they answer different questions, and confusing one for the other leads to resource prioritization mistakes that show up in the field.

It is also common for schedules to show significant total float but zero free float. In these cases, the project finish date may appear protected, but sequencing risk exists between trades. This is often where field conflicts emerge before the schedule shows any delay.

As the Project Management Institute (PMI) points out, once float is calculated, a string of critical activities emerges. This sequence, known as the critical path, has the smallest amount of float and represents the project’s total duration. The term “critical” underscores the minimal float in these activities – precisely, zero.

Float in CPM as an Indicator of Resource Priority

Differentiating between an activity with two months of float and one with zero is extremely important for managing resources. Obviously, everyone sees a red path surrounded by green and blue activities, but, float values are what indicates an activity’s criticality, making it also an indicator of how to prioritize resources. However, float should not be used as the sole driver of resource decisions. Artificial float caused by missing logic or phasing can make low-priority work appear flexible when it is not.

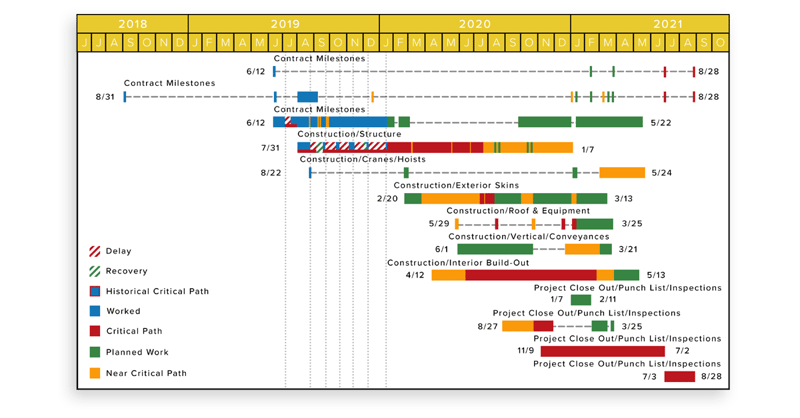

high-float-in-cpm-example

Explaining the Critical Path

Think of the critical path, highlighted in red, as your high-priority task list. These are the activities where prioritizing your resources and efforts is most important to meet your project’s deadlines. If any of these tasks are delayed and no acceleration happens to make up for it, the entire project will be delayed.

What About the Near-Critical Path?

Activities closely following the critical path are known as the near-critical path. These activities may not be on the critical path physically. However, they are still important because they have minimal float – usually around ten days on average, though this can vary depending on project size and complexity.

The Importance of Keeping an Eye on Near-Critical Activities

Activities with a total float value of less than 10 days should be considered near-critical. They require attention because they can quickly become critical if delayed. In particular, activities with less than five days of float (3-5 days) should be treated with similar urgency as those on the critical path.

Here's a Practical Scenario

Consider a project where your critical path consists of foundation work, framing, and roofing. These tasks are non-negotiable in their timelines. Meanwhile, tasks like electrical wiring or plumbing may have a bit more float but are near-critical. If the plumbing task has only four days of float, a delay here could quickly affect the critical activities that follow, such as installing fixtures or inspections.

How to Analyze Float in CPM Schedules

Relying on float values to make decisions is a proven tactic for resource management. However, scheduling has many pitfalls if you are unaware of best practices.

When reviewing a schedule, it’s important to analyze:

  • Average Float: Determine the average amount of float across all activities.
  • High Float Activities: Identify how many activities have more than two months of float (e.g., 44 days).

If you find that a large percentage (over 50%) of activities have more than two months of float, it might indicate missing logic in the schedule.

About Missing Logic

Excessive float is often not real flexibility – it is a symptom of missing logic. Large gaps between activities create the appearance of schedule cushion when no real buffer exists in execution.

The most important rule in CPM scheduling is that every activity, except the first in last, must have a predecessor and successor. This is important because, without logic, float opens up.

Typically, the more float opens, the more compressed the schedule becomes. By design, activities start stacking on their own, resulting in an erroneous critical path. While hard logic is usually present within the schedule, crew logic is often missing, causing timelines to become compressed and unrealistic.

What is Missing Crew Logic?

Crew logic is a form of “soft logic” that assigns relationships to activities that reflect where a crew will move next based on means, methods, and constraints. By connecting activities based on how work actually flows, this type of logic represents the flow of work in your schedule, not just contractual sequencing.

Float is an Indicator of Missing Crew Logic

Excessively high float across many activities suggests missing crew logic.

Additionally, if the critical path flows straight through the project without considering the trades involved, it is missing crew logic. For example, if you were building a high-rise with 80 floors and only the top floor was deemed critical but doesn’t account for the trades working on the intermediate floors, there would likely be an issue.

Constraints and Their Impact on Float in CPM

Constraints can also mask float erosion. A constrained schedule may show stable float values while risk is actually increasing behind the scenes. Placing constraints on activities, particularly finish constraints, can complicate your schedule analysis.

  • Constraints can turn activities with float values between 0 and 30 days red, making them seem critical.
  • The critical path may no longer reflect the true driving factors of the project.

Determining Acceptable Values of Float in CPM

For linear projects, I recommend minimizing float and lengthening the critical path to ensure steady project progression. On the other hand, for both horizontal and vertical projects, it’s vital to maintain a reasonable amount for all parties. A strategy to achieve this is by integrating crew logic into the scheduling process, which ensures that labor constraints are taken into account.

The goal is often to have a month or less of float in CPM. Shorter float durations allow for clearer visibility into when and where impacts happen. Having a tight schedule, meaning one that thinks through all necessary logic, allows for clear identification of the critical path that drives the project. This kind of schedule control ensures any impacts to the schedule can be identified and addressed promptly.

However, it is important to note that There is no universal “correct” float value. Acceptable float depends on project structure, phasing, permitting constraints, and sequencing strategy. Multi-phase projects may naturally show high float, while linear projects may operate with very little. The key is understanding whether float is structural or artificial.

Instead of relying on float as a buffer, many teams prefer structured contingency. Float is shared and uncontrolled, while contingency can be allocated, tracked, and governed. Treating float as contingency reduces transparency and weakens decision-making.

1. Analyze Project Complexity

Complex projects typically need more wiggle room to account for uncertainties. Assess the complexity by considering the following:

  • The number of activities and their interdependencies
  • Involvement of multiple trades and subcontractors
  • Duration and scope of the project.

2. Evaluate Historical Data

Review float values from similar projects in the past to identify patterns. Look at:

  • Average float durations that led to successful project completions
  • Float durations in projects that experienced delays or issues.

3. Assess Risk Factors

Consider potential risks that could impact your schedule, such as weather, materials, workforce, and approvals.

4. Use Industry Standards

Refer to industry benchmarks for float levels. SmartPM recommends:

  • Activities with less than 10 days of float are considered near-critical
  • Activities with 2-5 days of float should be treated as critical.
  • A total float value of over 44 days presents a significant risk to schedule quality.
  • An excessive amount of high-float activities (anything over two months) typically indicates flawed logic.

5. Implement Contingency Planning

Establish a buffer for high-risk activities. This might involve:

  • Allocating additional float to tasks with high uncertainty.
  • Scheduling buffer tasks between critical milestones to absorb delays.

However, float should not be used as a substitute for contingency. Float is a shared schedule resource that is consumed automatically. Contingency, on the other hand, is intentionally planned and allocated. Separating contingency from float improves transparency, accountability, and control over schedule risk.

6. Monitor and Adjust During Execution

Regularly update your schedule and adjust float based on project progress:

  • Use tools like SmartPM that automatically track changes and their impact on float.
  • Reallocate resources to manage tasks with diminishing float.

7. Define Float Guidelines

Set internal guidelines for acceptable float levels. For example:

  • Aim for an average float of 20-30% of total project duration.
  • No more than 20% of activities should be near-critical.

In essence, float can offer a buffer against unexpected changes, allowing activities to be postponed without impacting the overall end date.

8. Float Erosion as an Early Warning Signal

One of the most valuable uses of float is tracking erosion over time. When float decreases across updates, it indicates schedule stress even if the finish date has not moved. This is often the earliest signal that the project is drifting away from its planned completion date.

Slacking Off on Slack

Float is only as valuable as the CPM schedule; this comes with building your schedules with best practices and ensuring these best practices are maintained throughout the updating process.

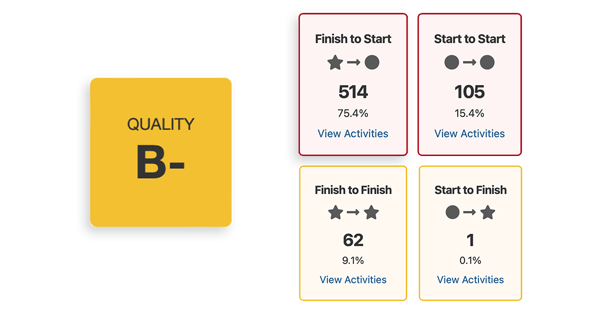

So, number one, ensure you have high schedule quality. In fact, several DCMA schedule quality checks are associated with float, including missing logic, high-float activities, and average activity total float.

Schedule quality control ensures schedules are built with best practices, allowing project teams to trust what their schedules are telling them. SmartPM streamlines the process of schedule quality control from baseline and throughout the updating process. If you’d like to learn more about how SmartPM can help you achieve smarter project management, request a demo, and we’d be happy to show you how.

Learn how the Critical Path Method (CPM) can help streamline complex construction projects by identifying key tasks, predicting timelines, and optimizing resource use in our complete guide.
