Strengthening Project Predictability with Schedule Performance Index (SPI)

SPI is invaluable for honing predictability. At its core, SPI represents the productivity rate within a project schedule.

A common wish among many AEC professionals is predictability—a reaction to the industry’s general unpredictability. The market state, supply chain concerns, rising interest rates, and the skilled labor shortage are all long-standing and converging… making the construction industry seem amidst a “perfect storm.” In this landscape, adopting strategies and tools that provide transparency into schedule performance is critical for more predictable outcomes.

SPI Insights Description
What is SPI?SPI measures the efficiency of time utilization in a project.

Formula SPI = Earned Value (EV) ÷ Planned Value (PV)
InterpretationSPI > 1: Ahead of schedule, SPI = 1: On schedule, SPI < 1: Behind schedule
Purpose Tracks schedule progress to identify and address delays early.
Benefits Enhances predictability, improves decision-making, and promotes proactive management.

Pause, Pivot, and Plan

The current environment is forcing many organizations to pause, pivot, and plan their upcoming project in more detail than ever before. One way to do so is with strategic, data-driven project management.

Effective management of construction projects requires accurate tracking and analysis of progress on-site. An essential metric for measuring project performance is your Schedule Performance Index (SPI).

You can gain valuable insight into your project’s health by calculating SPI based on Earned Value Analysis (EVA). Additionally, utilizing these metrics allows you to predict end dates more effectively.

What is SPI?

SPI is a performance metric that compares the actual progress of a project to the original plan. It gauges how far along the job is supposed to be versus how far along it is in reality.

 Simply put, it compares the value of work completed at any point in time (Earned Value, EV) to the value of work planned to be completed (Planned Value, PV). SPI reveals whether a project is ahead of schedule, on time, or running behind.

SPI is also part of Earned Value Management (EVM)—a comprehensive method used to track project performance and forecast future outcomes by combining cost, schedule, and scope data.

Key Benefits of SPI:

  • Enables accurate schedule tracking.
  • Highlights areas requiring immediate attention.
  • Facilitates better communication with stakeholders.
  • Provides data to forecast project completion dates.

Key Terms for Understanding SPI

Before calculating SPI, it’s important to familiarize yourself with key terms associated with EVM and SPI:

  • Earned Value (EV): The budgeted value of work completed at a given point.
  • Planned Value (PV): The budgeted value of work planned to be completed by that point.
  • Actual Cost (AC): The actual amount spent on completed work.
  • Schedule Variance (SV): The difference between EV and PV, indicating how far ahead or behind schedule the project is.
  • Cost Performance Index (CPI): A measure of project cost efficiency (EV divided by AC).

Together, these terms form the foundation of SPI calculations and provide a comprehensive picture of project performance.

Calculating SPI

You can help monitor and control project progress by utilizing Earned Value Analysis (EVA) to identify deviations from the planned schedule. SPI is calculated by dividing the Earned Value (EV) by the Planned Value (PV).

  • EV represents the value of work accomplished.
  • PV reflects the value of work planned to be done.

SPI Formula

The SPI ratio quantifies the efficiency of work performed relative to the work accomplished. Once calculated, the ratio will tell you the following:

  • SPI = 1: The project is on schedule.
  • SPI > 1: The project is ahead of schedule.
  • SPI < 1: The project is behind schedule.

SPI and Productivity Rate: Why is SPI Important?

SPI is invaluable for those wishing for more predictability. At its core, your schedule performance index represents the productivity rate of a project.

For instance, a project was anticipated to reach 85% completion, but in reality, it reached only 72%.

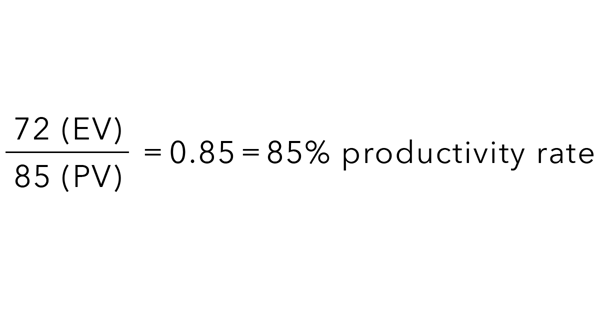

This gives the project an SPI of 0.85. An SPI of 0.85 means the project only achieves 85% of its planned productivity, indicating it’s behind schedule. If the SPI is consistently less than 1, as in this case, the remaining tasks will likely continue at the 85% productivity rate, potentially leading to an overrun.

To put it another way, if the productivity rate remains at 85%, a task projected to take 10 days would instead take approximately 12 days due to the reduced productivity.

With this understanding of SPI, stakeholders can make informed decisions. They might allocate more resources, reduce task durations, or adjust the project timeline. This ensures everyone involved has a clear picture of the expected project completion date.

When to Calculate Schedule Performance Index

SPI should not be a one-time calculation. Regular updates are critical to keeping a project on track. Ideally, SPI should be calculated at regular intervals, such as at key project milestones or in sync with schedule updates.

The frequency depends on:

  • Project Duration: Longer projects may require monthly SPI calculations, while shorter projects might benefit from weekly updates.
  • Project Type: High-stakes or high-complexity projects typically warrant more frequent SPI tracking to mitigate risks.

By calculating SPI consistently, project teams can detect trends, anticipate delays, and maintain schedule integrity.

How to Predict Project Outcomes with Your Schedule Performance Index

By applying the historical productivity rate, represented by the SPI, to the remaining duration of the project, you can gain insight into a more accurate project completion date. Using past data and earned value metrics can help forecast project end dates, but adhering to specific guidelines in the process is essential.

1. Be Accurate with Activity Durations

Every activity needs to have accurate duration estimates on both critical and non-critical path activities. Adjusting the schedule based on actual performance rather than hopeful expectations yields the best results.

2. Use High-Quality Schedules Throughout the Project

Before attempting to predict project outcomes, well-defined baseline schedules and their subsequent updates must be accurate. This is the only way to ensure that your reference point is valid enough to measure progress and calculate SPI throughout the project.

3. Track SPI Trends

Continuously monitoring and tracking SPI throughout your project helps identify patterns and trends in schedule performance. By analyzing SPI values at different project milestones or periods, you can assess if the project is consistently ahead or behind schedule.

4. Identify Deviations & Consider Project Factors

Taking into account various project factors that can impact SPI – such as changes in scope, resource availability, weather conditions, and unforeseen events – helps assess the potential impact of these factors on future project performance.

5. Forecast Future SPI:

You can predict future SPI values based on SPI trends throughout the project. For example, if the SPI has been consistently below 1, it indicates a likelihood of schedule delays. Conversely, if the SPI is consistently above 1, it suggests a potential for completing the project ahead of schedule.

6. Adjust Project Plans

By leveraging SPI and alongside other schedule performance trends, project teams can make informed decisions about future project outcomes. This enables proactive decision-making, early identification of schedule risks, and effective mitigation strategies to keep the project on track.

Using Schedule Performance for Enhanced Project Management

The drive towards improving predictability in the construction industry is not just a nice-to-have but an essential component to a project’s success. Enhanced predictability does more than just keep a project on track. It acts as a safeguard, reducing financial and safety risks while increasing stakeholder satisfaction. It also serves as a pivotal differentiator in a highly competitive market.

When construction firms like Mannon’s Manhattan Construction collaborate with advanced solutions such as SmartPM, they are not only tapping into cutting-edge technology but also fortifying their future. The success story of Manhattan and SmartPM showcases just how close we are to achieving impeccable precision–with a predicted end date nearly mirroring the actual completion. It’s a testament to what’s possible when the right tools are in play.

Improve Your Project Predictability With SmartPM

Navigating a complex project requires the right tools and strategies to ensure success. By mastering Schedule Performance Index, you can track progress with confidence, anticipate challenges, and keep projects on schedule.

To unlock the full potential of SPI and take your project management to the next level, explore solutions like SmartPM.

Book a demo today and see how advanced analytics can enhance your schedule efficiency, mitigate risks, and maximize project performance.

Frequently Asked Questions

How can I improve my project's schedule performance index?
Improving your project's Schedule Performance Index (SPI) involves adopting strategies that enhance planning, monitoring, and adjusting schedules effectively. Utilizing tools like SmartPM can streamline these processes by offering advanced analytics, real-time tracking, and actionable insights to keep your project on track.
The normal range for the Schedule Performance Index (SPI) is typically around 0.9 to 1.1. An SPI of 1 indicates that the project is exactly on schedule, while values above or below this range suggest variations in schedule performance.
CPI (Cost Performance Index) measures the cost efficiency of a project by comparing the value of work performed to the actual costs incurred, while SPI (Schedule Performance Index) evaluates schedule efficiency by comparing the work performed to the planned schedule. Together, these metrics provide a comprehensive view of project performance, enabling effective identification of cost and schedule variances.
CPI is measured by dividing the Earned Value (EV) by the Actual Cost (AC), expressed as CPI = EV / AC. A CPI value greater than 1 indicates the project is under budget, while a value less than 1 signals the project is over budget.
