Blog

Negative Float in Construction Scheduling: Causes, Risks, and How to Fix It



Negative float in a schedule shows up the moment a project's logic can no longer support its finish date. It is not a rounding error or a display quirk in Primavera P6. It is the project schedule telling a project team that the plan cannot deliver projects on the completion date it promises.

For project managers tracking project timelines across multiple jobs, catching negative float early is the difference between a manageable correction and a finish milestone that quietly becomes unrealistic.

Good project management depends on knowing the difference before it costs real time and money.

What Is Negative Float in a Schedule?

Negative float in schedule form is also called negative total float. It means an activity's total float has dropped below zero, indicating that the current activity can no longer finish without delaying the project's finish date.

Total float itself is the amount of time an activity can slip without pushing back the entire project. When total float is positive, an activity has room to move. When it hits zero, the activity sits on the critical path. When it goes negative, the schedule is reporting a conflict it cannot resolve on its own.

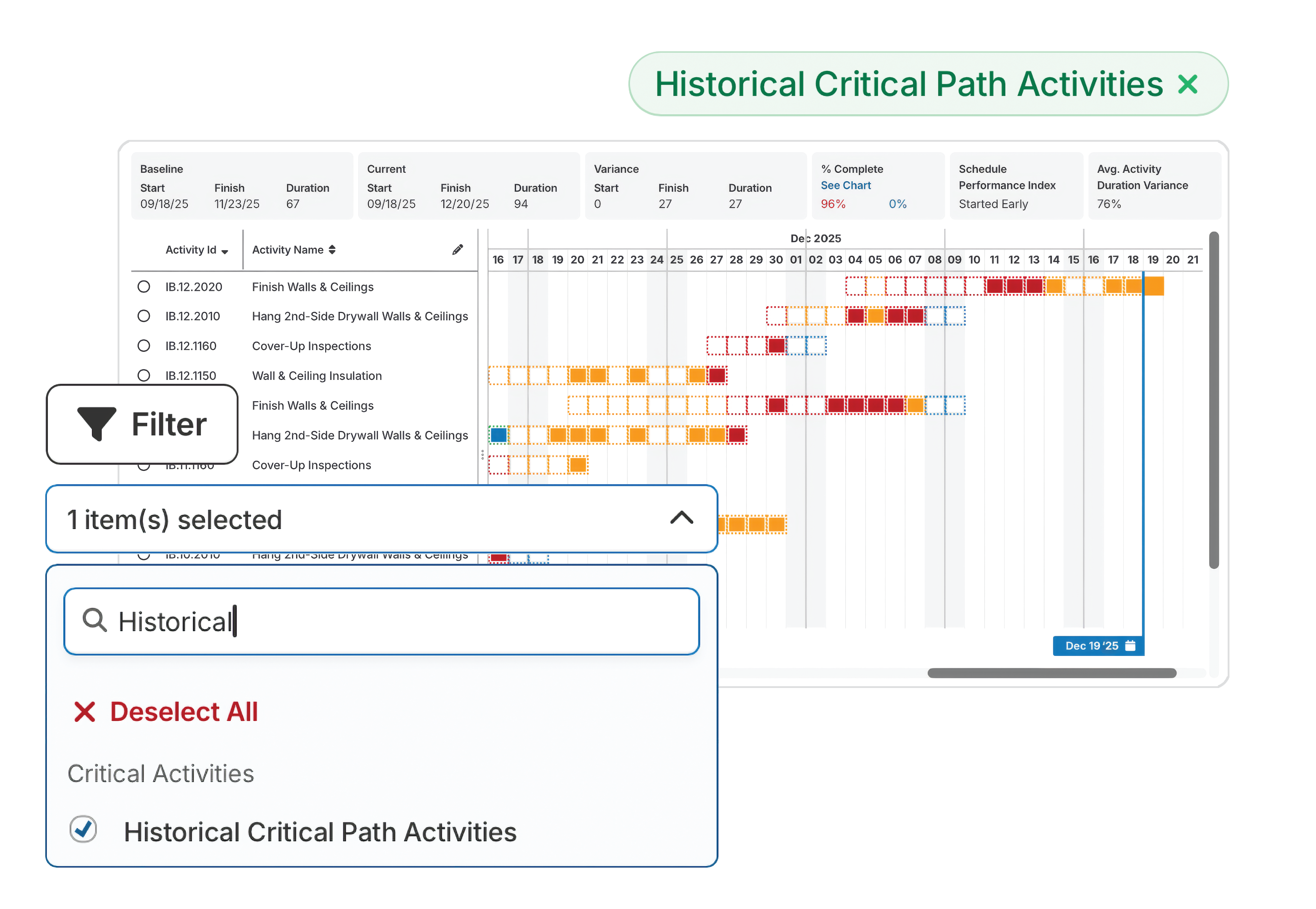

Gantt Page Historical Activities

How Total Float Is Calculated

To calculate total float, subtract early finish from late finish, or the early start date from the late start date. Primavera P6 computes this from the early dates and late dates in the forward and backward pass, producing float values for every completed and remaining activity in the network.

Finish float and start float should match under normal conditions. When out-of-sequence activities or logic breaks are present, the two can diverge, and P6 reports the smaller value.

Negative Float vs. Zero Float vs. Free Float

Zero float, sometimes called zero days of total slack, marks the critical path under normal conditions: no room to slip, but no conflict either. Critical activities sitting at zero float still reflect sound activity sequencing. Negative float means the plan has already broken that condition, consuming the project float meant to protect it.

Float Type

What It Measures

What It Means

Total float (positive)

Slack before an activity affects the finish date

Activity has room to move

Zero float

No slack; activity is on the critical path

Any delay pushes the finish date

Negative float

Total float has crossed below zero

The finish date is already at risk

Free float

Delay possible before affecting the next activity

Local flexibility, not entire-project flexibility

Free float measures how much a current activity can slip before it delays the early start date of the next activity, without regard to the project's critical path as a whole. An activity can have zero free float and still have positive total float, since free float only looks one step ahead.

What Causes Negative Float in a Schedule

Negative float rarely appears for one isolated reason. In forensic schedule reviews, the same root causes show up again and again across project activities, pulling the schedule away from its original plan.

Hard Constraints and Constraint Dates Not Being Met

A finish constraint or "must finish by" date is among the most common sources of negative float. When the calculated finish date runs later than the constraint date, the schedule generates a negative number for every activity driving that finish milestone.

Logic Ties and Relationship Types

Finish to start, start to start, and finish to finish relationships each pass float differently through the network. A negative lag on a finish to finish tie, or an unnecessary lag between activity A and activity B, can consume float meant to protect the schedule.

Out of Sequence Activities

Out of sequence activities, work that starts or finishes before its predecessor activity is logically complete, distort float calculations. Updates entered without correcting the underlying logic accumulate errors that surface as negative float downstream.

External Relationships Between Projects

External relationships, where one project's schedule ties to milestones in another project or a shared resource pool, can import negative float from outside the schedule under review.

Negative Float in a Baseline Schedule

Negative float should never appear in a primary baseline schedule. DCMA guidance treats it as a planning failure, not a progress issue, since no field performance yet exists to explain the shortfall. If a baseline shows negative float before work begins, the fix is to correct the logic or renegotiate the constraint before that baseline is approved, not after.



“What I see teams miss is the constraint or logic decision that created the negative float in the first place. They get focused on the number instead of asking why the schedule can no longer support the date.”

Mike Pink CEO of SmartPM



Why Negative Float Is a Warning Sign for Project Controls, Not Just Project Managers

Most guidance on negative float stops at the mechanics: find the constraint, adjust the logic, watch the number turn positive again. That treats the symptom, not the underlying issue. Negative float is one of the clearest early indicators that a delay claim is forming, well before either party uses the word "claim."

Negative float removed by changing logic ties or a constraint date, without addressing why the activity fell behind, does not fix anything. It hides the problem from the next person who reads the schedule, with no way of knowing a clean, positive float figure came from a logic change rather than real corrective action on site.

This pattern compounds across updates. A negative float condition "corrected" through a constraint change one month can resurface later as a larger problem, because the original cause was never resolved. Tracking these patterns is what separates surface-level review from real project controls.

"You can make negative float disappear pretty quickly if all you care about is making the schedule look better. But changing a constraint or adjusting logic doesn’t make the underlying problem go away. And if that schedule ever ends up in a dispute, now you have to explain not only what caused the delay, but why the schedule stopped showing it.”

Mike Pink CEO of SmartPM



Columbia Ventures, a commercial real estate developer, faced a delay claim covering nearly an entire multifamily project, with limited documentation to support either side. A traceable, update-by-update record of schedule performance gave both parties a factual basis for resolution. In their words: "SmartPM was instrumental in removing emotion in order to let the facts and data dictate negotiation."

How Negative Float Impacts Completion Dates and Project Risk

Negative float means the project's finish date, as currently modeled, is not achievable under the existing plan. Left unaddressed, this has direct consequences for project deadline exposure, cost, and the decision-making that keeps tasks and other activities moving on other projects too.

SmartPM's 2025 State of Construction Scheduling Report found that 76% of projects finish later than their original baseline, and undetected negative float is one of the earliest signals of that outcome.

What Unaddressed Negative Float Costs

Risk Area

What Happens

Completion date

Quietly slips even before the reported finish date on paper moves

Contract exposure

Liquidated damages clauses turn slippage into direct financial cost

Project cost

Extended general conditions and acceleration costs compound over time

Owner relationship

Undocumented delay weakens trust and invites dispute

Continuous schedule risk analysis, not just monthly milestones, is what lets a project team catch float erosion trending negative while there is still time for a low-cost correction.

How to Identify Negative Float Across a Portfolio

A single scheduler reviewing one schedule in Primavera P6 can usually spot negative float once they know where to look. The harder problem is a VP of Operations trying to know whether negative float exists across other projects in a fifty-project portfolio, without opening every file by hand.



Single-Project Review

Portfolio-Level Review

Method

Manual check inside Primavera P6

Automated check across every project at once

Scale

Works for one schedule at a time

Flags patterns across dozens of schedules

Detection speed

Depends on scheduler catching it during update

Surfaces on every update cycle automatically

Standard applied

Varies by reviewer

Consistent, checked against a defined framework

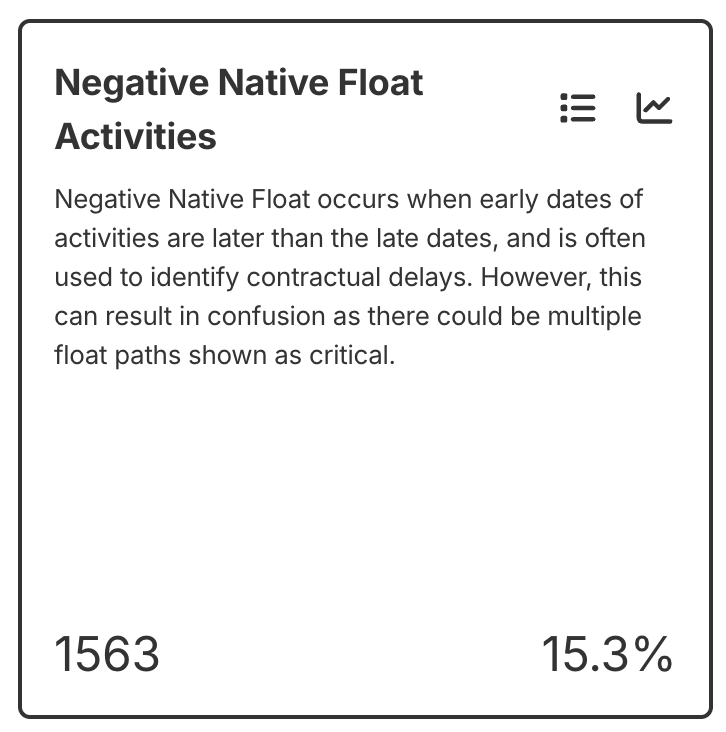

Screenshot 2026-08-11 at 3.59.06 PM

Reviewing float project by project does not scale, and negative float surfacing in one project this month often previews an issue that will show up next month. Portfolio-level visibility, checked automatically against a broader standard such as the DCMA 14-point check and SmartPM's 35+ quality metrics, turns a project-by-project chore into a repeatable, defensible process.

The GAO Schedule Assessment Guide sets out ten good practices for building reliable schedules, and the same discipline applies to catching negative float across a portfolio before it surfaces after the fact.

How to Fix Negative Float

Fixing negative float means resolving the underlying issues that produced it, not forcing the number back to zero. Catching the root cause earlier in the update cycle, for example, creates a real fix instead of a cosmetic one.

  1. Confirm the negative float is real, not a logic error. Verify that duplicate relationships or missing logic ties are not artificially producing the number. A solid CPM scheduling foundation makes this faster, since clean logic ties are what every float calculation depends on.
  2. Identify the driving constraint or relationship. Trace the critical path back to the specific hard constraint or relationship generating the negative float, usually the same predecessor activity across every downstream activity affected.
  3. Address the root cause, not the display. If a constraint date is not a contractual requirement, evaluate whether it should change. If the cause is a resourcing gap or an unlogged change order, document and address it directly.
  4. Consider schedule compression or resequencing where legitimate. Reducing lag, changing a finish to start relationship to start to start where physical work allows it, or adding resources are valid actions when the underlying work can support them.
  5. Re-baseline and document the change. Record any adjustment made, with the reasoning, so the schedule stays a defensible record rather than a moving target. AACE International's recommended practices provide the industry framework for documenting these changes for audit and claims purposes.

“There’s a big difference between fixing the negative float number and fixing the project. A scheduler can remove negative float with a few changes in P6, but resolving it means understanding what created the problem and making a change the field can actually execute. If nothing changed in the real plan, you probably didn’t solve anything.”

Mike Pink CEO of SmartPM



Following that sequence turns negative float from a recurring surprise into a resolved, documented issue.

Book a demo to see how SmartPM flags negative float and float erosion trends automatically, before they become disputes.



Frequently Asked Questions



Ready to stop finding negative float after it has already cost you time? Request a demo to see how SmartPM's schedule analytics catch it automatically.
