Blog
DCMA 14-Point Check vs. SmartPM’s 35+ Metrics for Construction Schedule Quality
SmartPM’s schedule quality framework goes beyond the limitations of the DCMA 14-Point Check with 35+ customizable metrics.
Trending
In construction project management, schedule quality is not just a compliance checkbox, it’s a performance driver that directly impacts delivery, profitability, and risk. Construction project control tools must do more than track progress, they need to validate schedule integrity and forecast risk.
For decades, the industry has relied on the DCMA 14-Point Check, originally developed by the Defense Contract Management Agency (DCMA) for Department of Defense (DoD) projects, to assess baseline schedule quality. This checklist was a critical first step toward structured scheduling, but it wasn’t built for the complexity and variability of today’s construction projects.
In fact, according to SmartPM’s 2025 State of Construction Scheduling Report, only 12% of baseline schedules meet best-practice quality standards. Even more concerning: fewer than 5% of projects maintain that level of quality through closeout. That means most teams are building and managing schedules that do not meet the structural criteria needed to control a project effectively.
That’s why SmartPM’s 35+ metric framework focuses on what actually drives successful project delivery.
What Is the DCMA 14-Point Check?
The DCMA 14-Point Check is a set of compliance-driven metrics used to evaluate Critical Path Method (CPM) schedules. It includes:
- Logic Checks
- Leads and Lags
- Relationship Types
- Hard Constraints
- High Float
- Negative Float
- High Duration Tasks
- Invalid Dates
- Resource Loading
- Missed Tasks
- Critical Path Test
- Critical Path Length Index (CPLI)
- Baseline Execution Index (BEI)
- Total Number of Tasks
Why the DCMA 14-Point Check Falls Short in Construction
While useful for government compliance, the DCMA framework often fails in real-world construction because:
- It applies one-size-fits-all thresholds, regardless of project type, size, or delivery method.
- It produces false positives and false negatives, flagging minor issues as critical while missing true risks.
- It doesn’t account for update integrity, field alignment, or dynamic risk management.
- It focuses on baseline integrity, not the reality of managing projects as conditions evolve.
Construction schedule analytics closes that gap by grading every update against the same metrics, so quality is measured as the job changes rather than once at the start.
How SmartPM Built a Smarter Schedule Quality Framework
At SmartPM, we’ve spent the last several years speaking with hundreds of general contractors, project owners, schedulers, and consultants. Through these conversations, we learned what matters most to project teams and what actually drives real-world project outcomes.
Construction analytics is only credible when the metrics behind it were chosen that way, from what teams actually manage against rather than what is easiest to compute.
We found that modern scheduling requires more than compliance checks; it needs tools that capture update accuracy, delay risk, field alignment, and real-time forecasting.
That’s why we developed a 35+ metric quality framework that addresses the realities of construction today.
Examples of SmartPM’s Additional Metrics
SmartPM goes beyond the DCMA’s checks to cover the areas where most projects break down. Here are a few examples of additional metrics we include:
- Dangling Activities
- Out-of-Sequence Work
- Duplicate Relationships
- Relationship Type Balance
- Activities Riding the Data Date
- Backdated Actuals
- Changed Actual Dates
- Remaining Duration Discrepancy
- Started with 0% Complete
- One-Day Activities
These metrics help project teams diagnose both structural and operational risks.
Customization That Reflects Real-World Complexity
Every project is different. That’s why SmartPM allows teams to customize their quality framework:
- Weighted Scoring: Prioritize key checks that match project risk.
- Flexible Settings: Tailor thresholds for specific job types, contract requirements, or delivery methods.
- Continuous Improvement: Use feedback loops to train teams and build better schedules over time.
Why Schedule Quality Is the Leading Indicator of Project Risk
According to SmartPM’s industry data, 76% of projects finish later than their original baseline, often because the schedules were never set up for success.
Common pitfalls include poor baseline quality, inconsistent updates, logic breakdowns, and delayed risk recognition and response.
When these issues accumulate, teams are forced into last-minute schedule compression, a costly workaround that increases failure risk. SmartPM helps teams spot these issues early, before they escalate into disputes, delays, and lost profitability.
Quality data is also the precondition for predictive analytics for construction scheduling, since a forecast inherits every logic defect in the file it was calculated from.
That's the same reason schedule optimization has to start with a quality check rather than a compression exercise: a plan built on flawed logic just relocates the failure point downstream.
How to Use SmartPM’s Schedule Quality Analysis
- Upload your project schedule (Primavera P6, MS Project, or Excel)
- Run SmartPM’s 35+ metric check
- Review findings: float, logic, out-of-sequence work, data accuracy, and more
- Get actionable recommendations to fix issues
- Update your schedule and track improvements over time

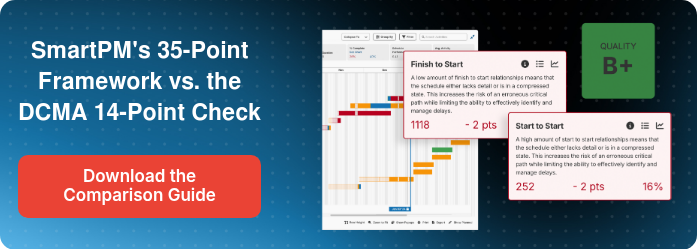

We’ve created a side-by-side comparison of SmartPM’s 35+ Quality Metrics vs. the DCMA 14-Point Check.
In today’s construction environment, managing schedule quality is about more than compliance, it’s about improving outcomes.
SmartPM’s schedule analysis platform helps project teams:
- Make smarter scheduling decisions
- Reduce costly delays
- Drive greater profitability
If you’re still relying solely on the DCMA 14-Point Check, it’s time to upgrade your approach.
Request a Demo to learn how SmartPM can help your team deliver projects on time, with fewer surprises.
Frequently Asked Questions
-
The DCMA 14-Point Check is a schedule quality assessment developed by the Defense Contract Management Agency (DCMA). It evaluates Critical Path Method (CPM) schedules for baseline integrity by checking for missing logic, excessive float, improper constraints, and other compliance metrics. Originally designed for Department of Defense (DoD) projects, it has become an industry standard but isn’t always suited for modern commercial construction.
-
Schedule quality is foundational to project success because it directly controls your ability to plan, forecast, and deliver. In construction, the schedule isn’t just a timeline, it’s the core dataset driving decisions about labor, materials, logistics, and risk.
If you start with a poor-quality schedule, you’re feeding bad data into your entire project control system. This is the classic “garbage in, garbage out” problem: flawed logic, missing links, unrealistic durations, or improperly sequenced tasks lead to inaccurate forecasts and unreliable progress tracking.
-
SmartPM expands beyond the DCMA 14-point schedule assessment with 35+ real-world scheduling metrics based on hundreds of conversations with customers and years of industry experience. These include critical path analysis with update integrity checks, contractor performance tracking, benchmarking tools for continuous improvement, automated diagnostic reports for risk mitigation.
-
SmartPM integrates with popular scheduling software, including Primavera P6, Microsoft Project and Phoenix. This allows teams to upload, analyze, and improve schedules quickly and seamlessly.
-
Getting started is simple:
-
Upload your schedule (P6, MS Project, or Phoenix)
-
Run the SmartPM quality check
-
Review diagnostic outputs with actionable recommendations
-
Make schedule adjustments and track progress over time
To learn more, Request a demo here.
-
