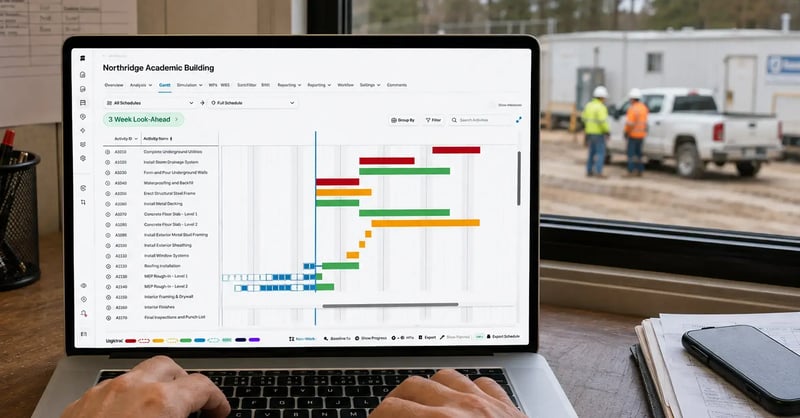

3-Week Look-Ahead Schedule

Blog

3-Week Look-Ahead Schedule: Template and Best Practices

A 3-week look-ahead is a short-interval plan that pulls the next three weeks of tasks out of the master schedule so crews, subcontractors, and suppliers know what happens next. The look-ahead schedule is a filtered view of the current project schedule update, broken down to the detail the field can act on. That distinction decides whether a look-ahead schedule helps a project or quietly works against it.

Most project teams create one every week. Far fewer create it from the current construction schedule. That gap is where delays hide, and why coordination breaks down on otherwise well-managed construction projects.

What Is a 3-Week Look-Ahead Schedule?

A 3-week look-ahead schedule is a rolling plan covering the next three weeks of upcoming tasks, extracted from the project schedule and expanded into detailed crew-level steps. It sits between the master schedule governing the project timeline and the weekly work plan, where subcontractors commit to specific tasks.

The Last Planner System, maintained by the Lean Construction Institute, places look-ahead planning at this layer, where teams prepare upcoming work by clearing potential constraints in advance. AACE International's schedule classification guidance makes the same point: different levels of detail serve different project stakeholders and must trace to one another.

A construction look-ahead schedule tracing cleanly to the CPM network is a management tool. One that does not is a wish list. The benefits are practical: better coordination between trades, earlier communication of potential issues, and shared focus on the tasks driving the project timeline. Reviewing it weekly turns those benefits into progress you can track.

Why the 3-Week Look-Ahead Window Works on Construction Projects

Three weeks is the shortest window that leaves time to clear a constraint before it becomes a delay, and two weeks does not. The lead times below are why.

Constraint

Period that governs it

Why three weeks matters

RFI response

Contract response period, commonly 7 to 14 days

An answer due on day 14 lands outside two weeks

Submittal review and materials release

Specified review period plus supplier lead time

Late orders surface while resequencing is still cheap

Inspections and permits

Notice period the AHJ requires

Access can be coordinated around the inspector

Crew and equipment mobilization

Notice period in the subcontract

Subcontractors allocate resources to real dates

The window is set by the periods the contract already grants, not by convention. Six weeks stretches past the point where crew-level detail stays accurate, so the back half gets rewritten before anyone uses it. Teams that maintain it identify challenges two or three weeks in advance, while adjustments are cheap and recovery costs stay low.

What Belongs in a 3-Week Look-Ahead Schedule Template

A useful 3-week look-ahead template is short and detailed only where detail changes a decision. Anything a look-ahead schedule template duplicates from the project schedule adds maintenance without value.

Field

Purpose

Activity ID

Traces each task back to the construction schedule

Task description

Detailed, plain language the field recognizes

Week 1 / Week 2 / Week 3

Where work falls across the next three weeks

Responsible party

The named trade partner or crew, with clear responsibilities

Predecessor status

Whether preceding tasks are complete, in progress, or behind

Total and free float

Room before the next task or the end dates move

Constraint and owner

The roadblock, who clears it, and by when

Commitment status

Committed, at risk, or not ready

The activity ID column is the one most project teams drop, and the one that matters most. Without it, a look-ahead schedule cannot be reconciled against its source.

Download the free 3 week look ahead template with the columns above, dropdowns, and one filled sample week.

Sequencing Upcoming Tasks Below the CPM Activity

Break each activity into the detailed crew-level tasks that make it real: hang, tape, sand, prime. Keep those tasks nested under the parent activity ID. Adding new logic inside the look-ahead creates a second plan without meaning to.

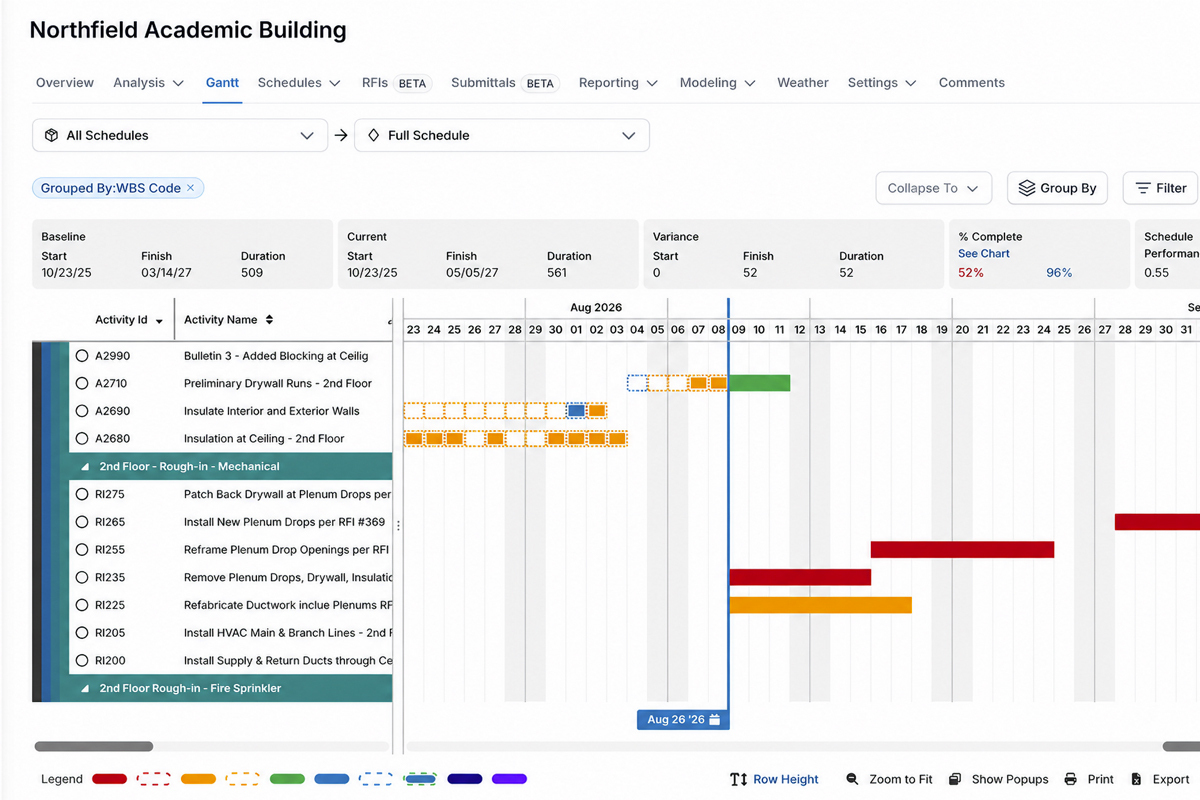

SmartPM Gantt View.png (1)

How to Build a Look-Ahead Schedule From the Master Schedule

Building a 3-week look-ahead construction schedule is a five-step routine. The order matters more than the format.

  1. Update the schedule first. Following CPM schedule updating best practices gives every downstream document a defensible start.
  2. Filter by data date. Pull tasks starting or finishing in the next 21 days. Do not build it from memory or last week's version.
  3. Break down and assign. Expand each activity into field tasks, confirm the scope, name who is responsible, and note access, materials, equipment, crew resources, and coordination needed.
  4. Log potential roadblocks with an owner and a date. A constraint without a name attached is only a note.
  5. Issue after the update, review before the week starts. Publish once per cycle so everyone focuses on one version.

Look-Ahead Drift: When the Construction Look-ahead Schedule and the Master Schedule Disagree

Look-ahead drift happens when the field plan and the CPM schedule are managed separately long enough to tell different stories about the same three weeks. It starts small. A superintendent resequences two tasks to keep crews productive, and the change never reaches the project schedule. Three months later, the look-aheads describe one sequence, the schedule baseline describes another, and every future update inherits the mismatch.

Nobody notices while it runs well. It surfaces in two ways.

The first is operational. Crews commit to sequences the critical path no longer supports, so free float on near-term activities gets spent on tasks that never drove the finish date.

The second is contractual. When a delay claim is filed, both records get produced. The GAO's Schedule Assessment Guide treats traceability as the foundation of a reliable project schedule, and inconsistency between contemporaneous documents is the first thing a reviewer checks.

When asked what reveals that look-aheads and CPM updates were being managed separately on a disputed job, and how far back those discrepancies typically go before anyone notices, Mike Pink, the CEO of SmartPM, says:

 “You can usually tell pretty quickly when the field and the schedule have been managing two different plans. The look-aheads show one sequence, the CPM updates show another, and eventually you can trace it back to a change in the field that never made it into the schedule. The problem is nobody notices while the work is moving, it becomes obvious when you have to explain a delay months later.”

Mike Pink CEO of SmartPM



 See whether your look-ahead and your project schedule still agree. Request a demo.

Which Metrics Show a 3 Week Look-Ahead Schedule Is Working

A look-ahead schedule is working when the field metric and the detailed schedule metric agree. Each pairing answers the same question from two directions, and disagreement is where to focus.

Field-side metric

Schedule-side metric

What disagreement means

Percent Plan Complete (PPC)

Schedule Performance Index (SPI)

Tasks were completed as promised, but not the tasks that mattered

Commitment reliability by trade

Baseline Execution Index (BEI)

One trade partner is absorbing float others assumed was available

Constraint aging

Float erosion

Roadblocks outlive the buffer covering them

Task count per week

Schedule compression

More work is pushed into the window than crews can absorb

SPI compares work completed against work planned; BEI counts tasks finished by their baseline date. Percent Plan Complete alone measures how well a team plans. Paired with schedule data, it shows whether planning is moving the project. Broader construction progress tracking puts both readings in one view. Reviewing them together shows project managers where to focus resources.

 When asked what is really happening when a team's Percent Plan Complete looks healthy but the schedule keeps slipping, and which metric should be trusted, Mike Pink, the CEO of SmartPM, says:



Delay Analysis and End Date Variance

3-Week Look-Ahead Best Practices and Common Mistakes

Six Essential Practices That Keep a Look-Ahead Honest

These separate a look-ahead that controls work from one that only documents it:

  • Use one data date. The look-ahead and its source update are managed from one status date.
  • Give the document one owner. One owner is more efficient, and shared editing produces versions rather than better coordination.
  • Name a person and a date for every constraint. Ownership turns a roadblock into a task.
  • Change the schedule when you change the sequence. Resequencing in the look-ahead alone is how drift begins.
  • Maintain every issued version. Archived look-aheads are contemporaneous records with evidentiary value.
  • Review it against the update, not instead of it. The look-ahead covers the next three weeks of future work; the schedule covers the project.

Three Mistakes That Create Liability

  • Rebuilding from scratch each week. Severs traceability and makes drift impossible to identify.
  • Dropping activity IDs. Reconciliation against the project schedule becomes impossible.
  • Showing progress the schedule does not support. Creates two records that will be compared.

 “The expensive mistake is letting the look-ahead become a separate version of what happened on the project. When a claim comes up, you're now trying to reconcile two records that were supposed to tell the same story. Keeping the activity IDs tied together and updating the CPM schedule when the field sequence changes prevents a lot of those arguments before they ever start.”

Mike Pink CEO of SmartPM



How Schedule Analytics Close the Loop on Your Look-ahead Schedule

A proprietary CPM engine sits on top of Primavera P6, Microsoft Project, or Phoenix, grades and tracks the update the look-ahead is drawn from, then shows whether last week's completed tasks moved the critical path. SmartPM does not create the project schedule or the weekly field plan. It measures whether the plan the field is focused on matches the plan the contract is measured against.

That reconciliation is essential on successful construction projects, where teams coordinate weekly rather than monthly to track progress. Delays caught in the first weeks cost days. The same delays found six weeks later carry real costs in crews, resources, and site access.

Weekly cadence is the practical barrier for most project managers. Automated construction schedule reporting removes it, with a built-in look-ahead report template that regenerates every update. Frampton Construction reports doing in ten minutes what once took two hours or more.
