Every construction project hits pressure points. Sometimes it’s a permit holding everything up. Other times, one delayed inspection snowballs into weeks of lost time. These pressure points are bottlenecks in construction scheduling, one of the biggest drivers of missed milestones, cost overruns, and disputes.
The challenge? Bottlenecks usually aren’t typically visible until they’ve already done damage. SmartPM’s new quality metrics change that. By tracking convergence bottlenecks and divergence bottlenecks (also called flashpoints), project teams can see risks before they cascade through the schedule.
What Is a Convergence Bottleneck?
A convergence bottleneck occurs when one activity has a high number of predecessors, meaning it can’t begin until many other tasks are finished.
Characteristics
-
High Predecessor Count: The more predecessors, the higher the chance that at least one will be delayed.
-
Critical Convergence Point: The activity becomes a vulnerable “checkpoint” in the schedule where multiple paths meet.
-
Impact: Even a single late predecessor can stall the bottleneck activity and push back everything that follows, especially if the activity sits on the critical path.
Configuration in SmartPM
By default, SmartPM flags any activity with five or more predecessors as a convergent bottleneck. However, the threshold is customizable in the quality profile so it can be tuned to match the complexity or risk tolerance of each project.

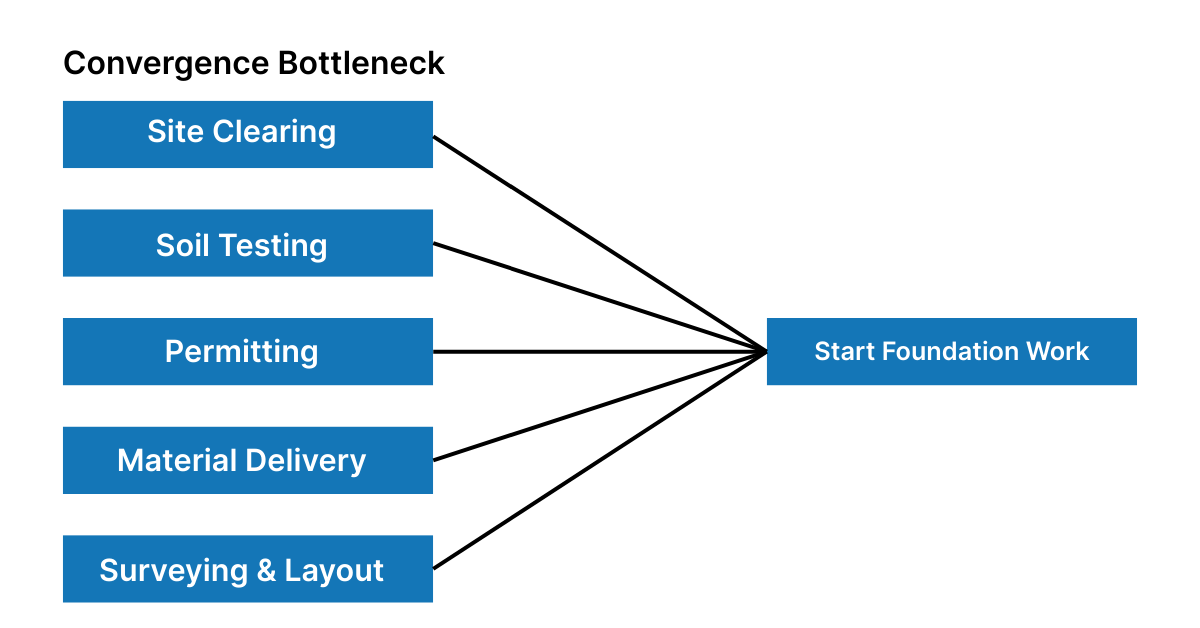

Example: A task like Start Foundation Work may depend on site clearing, soil testing, permitting, and material delivery. If any one of those slips, foundation work is blocked.
Risk & Impact
The activity can’t start until all of its predecessors are finished. If even one upstream task is delayed, the bottleneck activity, and everything dependent on it, will also be delayed.
Best Practices
-
Monitor Predecessors Closely: Track completion rates for all upstream tasks to reduce surprises.
-
Mitigate Risk Early: Add buffers or explore parallel sequencing for especially sensitive tasks.
-
Review Thresholds Regularly: On larger, more complex projects, consider raising the threshold to avoid over-flagging. For smaller projects, lower it so you don’t miss important risks.
What Is a Divergence Bottleneck?
A divergence bottleneck, or flashpoint, happens when one activity has a high number of successors, tasks that can’t start until it is finished.
Characteristics
-
High Successor Count: The activity acts as a gatekeeper for multiple downstream trades.
-
Critical Divergence Point: A single slip has the potential to hold up entire clusters of work.
-
Impact: The delay can cascade into resource conflicts, cost overruns, and missed milestones across several teams.
Configuration in SmartPM
By default, SmartPM flags any activity with five or more successors as a divergent bottleneck. Like with convergent bottlenecks, this threshold is fully customizable so teams can calibrate it to their project’s scale and complexity.

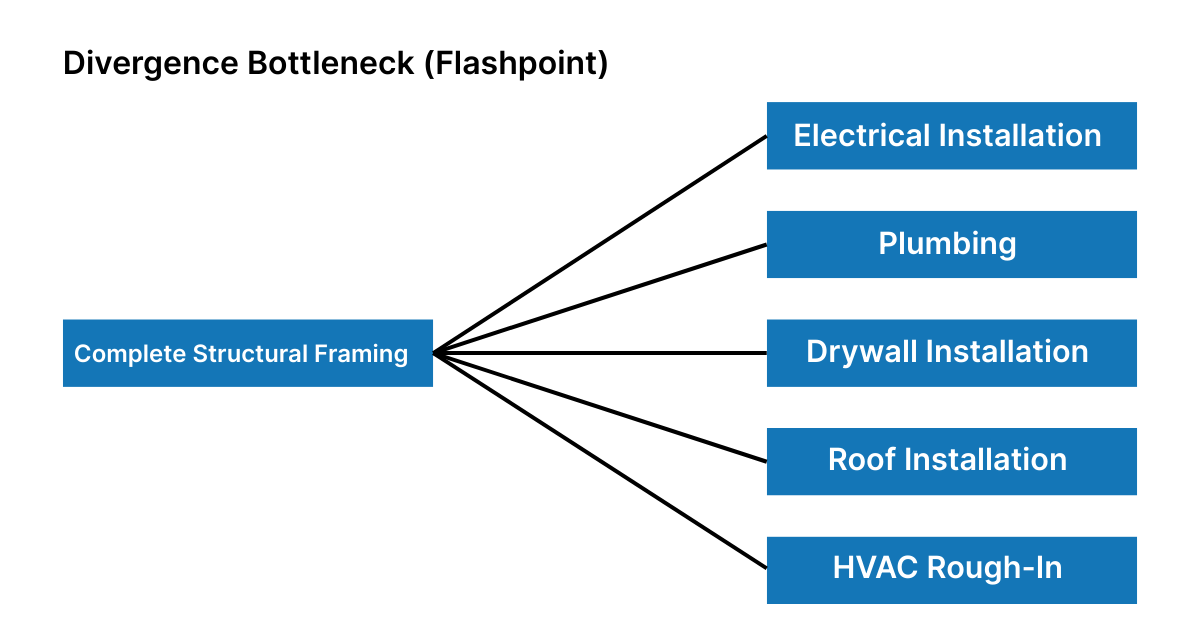

Example: Complete Structural Framing must be done before plumbing, electrical, drywall, and HVAC can start. A delay here doesn’t just push one activity, it stalls several trades and disrupts overall flow.
Risk & Impact
A delay in an activity cascades into multiple downstream tasks. This ripple effect can lead to trade conflicts, resource pileups, milestone slips, and higher costs.
Best Practices
-
Track Successors in SmartPM: Keep an eye on the activities most dependent on bottleneck tasks to see where risk is highest.
-
Have Contingency Plans: Options like fast-tracking or reassigning resources can reduce downstream impacts.
-
Adjust Thresholds Thoughtfully: Lower thresholds may make sense for smaller projects, while larger projects may require higher ones to focus only on the most critical points.
Why These Metrics Matter for Schedule Quality
By identifying convergence and divergence bottlenecks, SmartPM enables project teams to:
- Spot hidden risks early before they create real delays
- Focus resources where they matter most to maintain flow
- Improve reliability by monitoring activities with the highest potential impact
- Customize thresholds to fit each project’s complexity (default: 5 predecessors or successors, adjustable in settings)
These insights turn bottleneck management from reactive to proactive, helping both site teams and executives keep projects on track.
Challenges in Managing Bottlenecks
While these metrics provide powerful visibility, it’s important to use them thoughtfully. Setting thresholds too low can overwhelm teams with “false alarms,” flagging too many activities as bottlenecks and making it hard to focus on the ones that truly matter.
On the other hand, thresholds that are set too high risk under-identifying critical tasks, especially on smaller projects where just a few dependencies can still create significant risk.
Another common challenge is dependency mismanagement. If schedule logic is incomplete or incorrect, bottlenecks may be flagged inaccurately. For example, missing predecessors or successors in the schedule can skew the analysis.
Similarly, convergent bottlenecks can strain resources if many tasks all need to finish at once, while divergent bottlenecks can overload trades if multiple downstream activities get triggered together.
Finally, bottleneck analysis works best when numbers are paired with context. While SmartPM highlights activities with many predecessors or successors, qualitative factors like task importance, resource availability, or external constraints (such as weather or permitting delays) should also be considered.
Customizing thresholds for each project phase and supplementing analytics with human insight ensures the most accurate picture of project risk.
How SmartPM Helps
With this release, Convergence and Divergence Bottlenecks can be tracked in the Schedule Quality dashboard.
- Field teams can see where handoffs are most vulnerable.
- Executives gain visibility into high-impact activities that could disrupt milestones.
- Thresholds are customizable so the dashboard highlights what’s most critical for each project.
Instead of reacting to delays after they’ve already spread, SmartPM gives you the data to prevent them.
