n construction project management, one principle holds true across all sizes and scopes of work: risk is inevitable.
That’s why smart project teams don’t just react to risks, they plan for them. One of the most effective tools in a proactive risk management process is the Risk Breakdown Structure (RBS).
A risk breakdown structure organizes potential project risks into a clear hierarchy, helping construction teams identify what could go wrong, where those risks are most likely to appear, who owns them, and how they should be monitored. For contractors, owners, schedulers, and project controls teams, the RBS is especially useful because construction risk often shows up through schedule delays, float erosion, missed milestones, procurement issues, design coordination problems, and end-date exposure.
This guide walks through what an RBS is, how it functions in the construction industry, the four core construction risk categories, how to build one, a practical high-rise project example, how RBS differs from WBS, common mistakes to avoid, and how tools like SmartPM help move risk planning from a static structure into measurable CPM schedule intelligence.
Quick Answer: What Is a Risk Breakdown Structure in Construction?
A Risk Breakdown Structure (RBS) in construction is a hierarchical framework that organizes project risks into categories and subcategories so teams can identify, assess, assign, monitor, and mitigate risks before they affect cost, schedule, quality, or safety.
In simple terms, an RBS answers:
- What types of risks could affect the project?
- Where are those risks most likely to occur?
- Which risks matter most?
- Who owns each risk?
- What mitigation actions should be planned?
- Which risks are already appearing in project data?
An RBS organizes risk categories. SmartPM helps construction teams go a step further by identifying which risks are actually appearing in CPM schedule data, including float erosion, delay trends, missed milestones, logic changes, and end-date exposure.
Quick Insights: Risk Breakdown Structure in Construction
- What it is: A Risk Breakdown Structure (RBS) is a hierarchical framework used to identify, categorize, and manage potential project risks in construction.
- Core categories: Most RBS models encompass four key risk areas: Technical, Organizational, External, and Project Management.
- RBS vs WBS: An RBS organizes risks, while a Work Breakdown Structure (WBS) organizes project deliverables and work packages.
- Why it matters: An RBS brings clarity to risk planning, helps prioritize mitigation efforts, and improves team communication and accountability.
- Key benefits: Early risk detection, stronger alignment with project goals, proactive scheduling and budgeting, better risk reporting, and improved forecasting.
- Smart integration: When paired with a WBS, a RACI matrix, and tools like SmartPM’s analytics platform, an RBS becomes a central pillar of effective construction project controls.
- Schedule intelligence: An RBS shows how risks are organized. SmartPM helps teams see which risk categories are actually affecting CPM schedule performance through float erosion, delay trends, missed milestones, and end-date exposure.
What Is a Risk Breakdown Structure in Construction?
A Risk Breakdown Structure (RBS) in construction is a hierarchical framework that organizes potential project risks into categories and subcategories, making it easier for teams to identify, assess, assign, and mitigate risks before they impact cost, schedule, quality, or safety.
Much like a Work Breakdown Structure (WBS) breaks a project into manageable components, an RBS dissects project risks into structured levels. Used across methodologies like Agile and PMBOK, an RBS supports risk identification, prioritization, and mitigation throughout the project life cycle.
In the construction context, an RBS helps project teams visualize risk areas across the entire project life cycle, making it easier to align mitigation strategies with the project’s objectives and deliverables. When connected to construction schedule risk analysis, it also helps teams understand which categories are most likely to drive delay, float erosion, or end-date exposure.
For example, a construction team may use an RBS to group risks under broad categories such as:
- Technical risks
- Organizational risks
- External risks
- Project management risks
Each category can then be broken down into more specific subcategories, such as design coordination issues, insufficient resource allocation, regulatory changes, supply chain interruptions, inaccurate scheduling, or late stakeholder decisions.

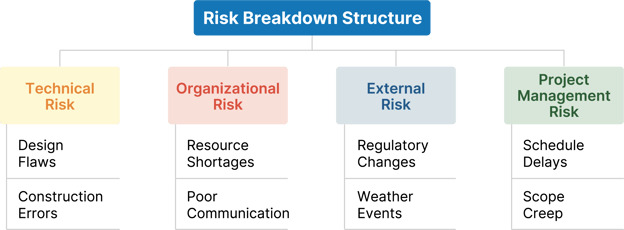

Example of a Risk Breakdown Structure with core construction risk categories and subcategories.
The 4 Core Construction Risk Categories
While each construction project comes with its own specific risks, most RBS frameworks categorize risks into four major areas:
1. Technical Risks
These involve the design, technology, engineering, and execution of the project. Common examples include:
- Inaccurate drawings
- Untested construction methods
- Errors in technical specifications
- Misaligned structural components
- Design coordination issues
Misalignment in technical expectations can severely compromise timelines and quality. On active construction projects, these risks often surface as rework, sequencing conflicts, late design clarifications, or schedule activities that cannot start as planned.
2. Organizational Risks
Internal dynamics within the organization or among stakeholders fall into this category. Common examples include:
- Insufficient resource allocation
- Inadequate communication among departments
- Shifts in organizational strategy
- Leadership gaps
- Poor coordination between teams
Poor coordination and leadership gaps can derail even well-planned projects. These risks can also create unclear accountability, slow decision-making, and inconsistent follow-through on mitigation actions.
3. External Risks
These arise from outside the project's control. Common examples include:
- Economic downturns
- Regulatory changes
- Legal disputes
- Extreme weather
- Supply chain interruptions
- Material price escalation
External risks are often harder to predict but can have a significant impact on both budget and schedule. Because construction projects rely heavily on approvals, materials, labor availability, and site conditions, external risks should be monitored continuously throughout the project life cycle.
4. Project Management Risks
This category captures risks related to planning and execution oversight. Common examples include:
- Inaccurate scheduling
- Unclear project scope
- Dependency issues
- Ineffective communication channels
- Poor update quality
- Late stakeholder decisions
These risks can hinder the project team's ability to make timely decisions and stay on track. They are especially important for teams using CPM schedules because poor update quality, missing logic, or inaccurate sequencing can hide risk until delays have already affected the project.
Understanding these four pillars of risk enables more accurate risk analysis, encourages collaboration during brainstorming, and creates transparency in project planning and execution.
Pairing the RBS with schedule-level risk analysis connects those categories to measurable CPM data, so the team can see which risk areas are actually driving float erosion and end-date exposure in the current schedule. For teams focused on schedule performance, this is where RBS connects directly to construction project controls and schedule-driven decision-making.
Risk Breakdown Structure Example for Construction Projects
Below is a simplified example of how a construction team might organize an RBS for a high-rise project. This is not a complete risk register. It is a structured way to group risk areas before assigning owners, scoring impact, and defining mitigation plans.
|
RBS Level 1 |
RBS Level 2 |
Example Risk |
Possible Schedule Impact |
|
Technical Risks |
Design coordination |
Inaccurate drawings or misaligned specifications |
Rework, delayed approvals, resequencing |
|
Technical Risks |
Construction methods |
Untested construction methods |
Slower production, quality issues, missed milestones |
|
Organizational Risks |
Resource allocation |
Insufficient labor or equipment planning |
Activity slippage, reduced productivity |
|
Organizational Risks |
Communication |
Inadequate communication among departments |
Late decisions, unresolved conflicts |
|
External Risks |
Weather |
Extreme weather |
Work stoppages, float erosion |
|
External Risks |
Supply chain |
Material lead time issues or supply chain interruptions |
Delayed starts, procurement-driven critical path changes |
|
Project Management Risks |
Scheduling |
Inaccurate scheduling or poor update quality |
Hidden delay trends, unreliable forecasts |
|
Project Management Risks |
Scope |
Unclear project scope |
Change impacts, disputed responsibility |
This structure helps teams move from broad risk awareness to practical mitigation planning. For example, if supply chain interruption appears under External Risks, the team can connect that risk to procurement activities in the CPM schedule, review affected milestones, assign an owner, and monitor whether float is eroding over time.
This is also where SmartPM adds value. The RBS organizes risk categories, while SmartPM helps teams identify which risks are actually appearing in schedule data through:
- Float erosion
- Delay trends
- Missed milestones
- Logic changes
- Critical path movement
- End-date exposure
- Schedule update quality issues
In other words, the RBS helps define what to watch. SmartPM helps show what is happening.
Risk Breakdown Structure vs Work Breakdown Structure
An RBS and a WBS are related planning tools, but they organize different things.
|
Framework |
What It Organizes |
Primary Purpose |
Construction Example |
|
Risk Breakdown Structure (RBS) |
Project risks by category and subcategory |
Helps teams identify, assess, prioritize, assign, and mitigate risks |
Technical risks such as design errors, external risks such as material delays, project management risks such as poor sequencing |
|
Work Breakdown Structure (WBS) |
Project deliverables and work packages |
Helps teams plan, scope, assign, and manage the work required to complete the project |
Sitework, foundations, structural steel, MEP rough-in, interiors, commissioning |
RBS and WBS are different, but they work best together. The WBS shows what work must be completed, while the RBS shows what could threaten that work.
For example, if the WBS includes “Structural Work,” the RBS should identify technical, external, organizational, and project management risks that could affect that work package. Those risks may include design coordination issues, material delays, insufficient resources, inaccurate sequencing, or late stakeholder decisions.
This connection helps teams move from general risk awareness to practical mitigation planning, especially when paired with construction scheduling software and analytics that connect risk categories to schedule performance.
Simple Risk Breakdown Structure Template
Use the following simple RBS template to structure construction project risks before transferring them into a risk register, project controls workflow, or schedule analytics process.
|
Field |
What to Include |
|
RBS Category |
Technical, Organizational, External, or Project Management |
|
Subcategory |
More specific risk area, such as design coordination, resource allocation, weather, procurement, or scheduling |
|
Risk Description |
A clear statement of the risk event |
|
Potential Impact |
Cost, schedule, quality, safety, scope, or stakeholder impact |
|
Probability |
Likelihood of the risk occurring |
|
Impact Level |
Expected severity if the risk occurs |
|
Risk Score |
Combined probability and impact rating |
|
WBS Link |
Related deliverable, phase, or work package |
|
Schedule Link |
Related CPM activity, milestone, path, or dependency |
|
Risk Owner |
Person or team responsible for monitoring and response |
|
Response Strategy |
Avoidance, reduction, transference, or acceptance |
|
Mitigation Action |
Specific action the team will take |
|
Status |
Open, monitoring, mitigated, accepted, or closed |
A basic RBS template is most useful when it does not sit apart from the project schedule. For construction teams, each major risk should connect back to the plan through WBS elements, CPM activities, milestones, or schedule paths.
That connection is what allows the team to monitor whether a risk is only theoretical or already showing up in project performance.
How to Build an Effective Risk Breakdown Structure
To maximize the impact of your RBS, follow structural best practices that keep it clear, practical, and aligned with project goals.
Right-size the RBS
Avoid overcomplicating the structure. An effective RBS should be detailed enough to provide clarity without becoming overly granular or redundant. Each risk should belong to one clear subcategory.
Use MECE thinking
Make categories and subcategories mutually exclusive and collectively exhaustive. In other words, avoid overlap while ensuring all significant risk areas are covered. This helps prevent duplicate entries and missed risks.
Align with the WBS and project deliverables
Structure your RBS to mirror the Work Breakdown Structure where possible. This enables direct correlation between risks and deliverables or work packages, simplifying accountability and response planning.
For broader planning context, teams can also connect this process to construction project planning so risk identification is part of the plan from the start, not added after execution begins.
Build in flexibility
Your RBS should be a living document. As the project life cycle progresses, new risks may emerge and others may become irrelevant. Build in checkpoints for updates and version control.
Standardize format and language
Use consistent terminology and formatting so all stakeholders, from field crews to executives, can easily interpret the structure.
Tie risks to ownership
Assign ownership for each risk category or subcategory using a RACI chart (Responsible, Accountable, Consulted, Informed). This drives engagement and accountability.
Connect to schedule data
For construction teams, the most useful RBS is not just a list of possible risks. It should connect to real schedule conditions, including delays, logic changes, float trends, missed milestones, and end-date exposure.
SmartPM strengthens this process by helping teams identify whether the risks organized in the RBS are actually appearing in CPM schedule data. That means risk planning can be connected to measurable project conditions rather than relying only on static risk lists or subjective status updates.
Aligning RBS with WBS and RACI for Practical Team Workflows
For an RBS to drive real impact, it needs to be integrated with two key planning frameworks: the Work Breakdown Structure (WBS) and the RACI matrix.
RBS + WBS Integration
Aligning your RBS with your WBS means organizing risks around the same structure used to plan and execute project deliverables.
For example, if your WBS includes “Structural Work,” the RBS should capture technical risks like design errors or material defects associated with that work package. This allows risk analysis and mitigation to be embedded directly into the execution plan, rather than treated as a separate planning exercise.
Assigning Risk Ownership via RACI
Each risk item in the RBS should have an assigned owner using the RACI framework:
- Responsible: Person or team who will address the risk.
- Accountable: Person ensuring the risk is managed.
- Consulted: Subject matter experts offering input.
- Informed: Stakeholders kept up to date on status.
Linking risk items to WBS elements and defining ownership through RACI ensures that risk management isn’t a siloed activity, but an embedded practice across planning, scheduling, and execution.
That embedded practice is what separates a risk register from an actual planning process. It is also the piece that tends to go missing when RBS work gets treated as a deliverable rather than a discipline.
Advanced Risk Analysis Techniques
For project teams seeking deeper insights into risk exposure and organizational readiness, the RBS can support advanced risk analysis techniques that go beyond identification and scoring.
Risk Aggregation
Quantitative methods such as Monte Carlo simulations or weighted scoring models can be applied to roll up individual risk scores across subcategories and categories. This gives project managers a clear view of total risk exposure at the project or program level, enabling more strategic allocation of contingency reserves.
Root Cause Analysis
Extend the RBS by linking individual risks to their root causes or triggers. This might include creating a dependency map that shows how one risk might trigger others. Tools such as the “5 Whys” or Fishbone Diagrams (Ishikawa) can help identify underlying contributors to systemic project risks.
Mapping those triggers is the starting point. A full root cause analysis follows each one back through the schedule to the single activity or decision that set the risk in motion.
Scenario Planning
Use the RBS as a foundation for stress-testing different project outcomes. Ask “What if?” questions around high-impact risk categories and model their potential influence on budget, timeline, or resource availability.
Heat Mapping and Thresholds
Apply color-coded risk heat maps or conditional formatting in your risk register to quickly visualize which areas of your RBS demand urgent attention.
When integrated into your RBS framework, these methods strengthen decision-making and allow for more proactive and data-driven risk mitigation strategies. For schedule-focused risk visibility, teams can also use construction analytics to identify patterns that may not be obvious from a static risk register alone.
Why Use a Risk Breakdown Structure?
An RBS brings clarity and structure to the otherwise overwhelming task of risk identification. Here are key reasons to use one:
Standardized Risk Categorization
Avoids redundancy and ensures all sources of risk are considered. A well-structured RBS allows project teams to look at the big picture and drill down into detailed subcategories of risk that may otherwise go unnoticed.
Better Risk Analysis
Facilitates accurate risk assessment, including calculating risk exposure, ranking the levels of risk, and assigning a risk score. By quantifying potential impact and probability, teams can focus on significant risks that threaten project success the most.
Improved Communication
Helps stakeholders and team members speak the same language when discussing risks. An RBS provides a shared framework for discussing challenges, allowing for better risk reporting, alignment during meetings, and more cohesive decision-making.
Actionable Mitigation Strategies
Aligns mitigating risks with real-world priorities and resource constraints. Because risks are categorized and prioritized, the RBS naturally supports more strategic and efficient deployment of mitigation strategies.
Supports Compliance and Auditing
Structured risk documentation and classification help organizations meet regulatory or contractual obligations, particularly when working on large-scale or public construction projects.
Enhances Planning for Future Projects
Historical RBS data can inform future projects, acting as a template to predict recurring or emerging risk factors. This builds long-term resilience into your risk management efforts.
How to Make a Risk Breakdown Structure for a Project
1. Identify Risk Categories for the RBS
Start by selecting broad risk categories that reflect the nature of your construction projects. Use historical project data and feedback from previous post-mortems.
Involving cross-functional input during this stage, particularly from scheduling, procurement, and design teams, can ensure no critical risk area is overlooked.
Common construction RBS categories include:
- Technical risks
- Organizational risks
- External risks
- Project management risks
For a deeper risk planning workflow, teams can also reference this guide to risk assessment in construction projects.
2. Break Down Specific Risks in the RBS
Once the top-level categories are defined, subdivide them into individual risks or subcategories.
For example, under “External Risks,” break out environmental regulations, material lead times, and subcontractor performance. Under “Project Management Risks,” include inaccurate scheduling, poor update quality, unclear scope, dependency issues, and late stakeholder decisions.
Use brainstorming sessions with subject-matter experts and lessons learned from prior construction projects to flesh out realistic and relevant risk events.
3. Score the Risk and Impact
Use a structured risk register to document each risk with consistent fields such as description, source, category, probability, and impact.
Assign a risk score using a matrix that evaluates likelihood against potential impact. This scoring system enables teams to prioritize high-risk areas and flag major risks early.
It’s also valuable to identify dependencies between risks, which can escalate overall risk exposure if left unaddressed.
4. Define Risk Responses and Mitigation Tactics
For each significant risk, document a proactive risk response strategy. This may include:
- Avoidance
- Reduction
- Transference
- Acceptance
Each response should include associated mitigation strategies and contingency plans. The goal is to ensure that team members are prepared and empowered to act swiftly when a risk materializes.
5. Review and Iterate Throughout the Project Life Cycle
An RBS is not static. As the project progresses, new risk factors may emerge while others become obsolete.
Schedule regular reviews to update the RBS and risk management plan, ideally aligning with project milestones or schedule updates. Use insights from risk reporting to refine rankings and improve planning for future projects.
For construction teams, this review should also include schedule-based evidence. If the RBS identifies procurement risk, for example, the team should look for related CPM schedule impacts such as slipping material-related activities, increasing float erosion, missed milestones, or changes to the critical path.
Benefits of Using a Risk Breakdown Structure
A well-built RBS gives construction teams a structured way to identify, communicate, and manage risk throughout the project life cycle.
Key benefits include:
- Early Detection: Identifies risks during the project planning stage before they escalate into costly issues.
- Better Alignment: Connects risk factors with project objectives, ensuring strategic focus and operational clarity.
- Strategic Response: Supports the creation of tailored risk response and mitigation strategies that directly address the most pressing threats.
- Comprehensive Reporting: Enhances risk reporting capabilities by standardizing data, which simplifies auditing, communication, and documentation.
- Scalability: Works across projects of all sizes, from small renovations to complex infrastructure builds and software development initiatives.
- Increased Accountability: Ensures risks have assigned owners, boosting responsibility and follow-through.
- Improved Forecasting: Enables proactive adjustments to timelines and budgets based on known risk exposure.
- Total Risk Reduction: Minimizes the overall footprint of risk on the project through early identification, structured categorization, and consistent monitoring.
- Improved Schedule Awareness: Helps teams connect risk categories to activities, milestones, float trends, and schedule paths.
- Stronger Project Controls: Supports more disciplined planning, reporting, and decision-making across the project team.
The biggest advantage is not simply having a risk hierarchy. The real value comes when the RBS is connected to live project information. In construction, that means connecting risks to the CPM schedule, update quality, milestone performance, float movement, and end-date exposure.
SmartPM helps teams make that connection by turning schedule data into risk visibility. Instead of only asking which risks might occur, teams can see which risks are already affecting performance.
Common RBS Mistakes to Avoid
Even a well-intentioned RBS can lose value if it is not built and maintained correctly. Avoid these common mistakes:
Making the RBS Too Complicated
An RBS should create clarity, not confusion. If the structure is too detailed, teams may struggle to maintain it or agree on where each risk belongs.
Treating the RBS as a One-Time Document
Risk conditions change throughout the project life cycle. A useful RBS should be reviewed as design, procurement, scheduling, and field conditions evolve.
Failing to Assign Risk Owners
A risk without an owner is unlikely to be managed consistently. Use a RACI matrix or similar ownership model to define who is responsible, accountable, consulted, and informed.
Not Connecting Risks to the WBS
If risks are not connected to deliverables or work packages, it becomes harder to understand where they may affect execution.
Not Connecting Risks to the Schedule
In construction, many risks eventually show up in the CPM schedule. If the RBS is not connected to schedule data, teams may miss early warning signs such as float erosion, missed milestones, delayed starts, or critical path movement.
Using Generic Categories Without Construction Context
Broad categories are helpful, but they need construction-specific subcategories. For example, “external risk” is too broad by itself. It should be broken into more actionable subcategories such as regulatory changes, extreme weather, supply chain interruptions, or material price escalation.
Ignoring Update Quality
If schedule updates are incomplete or inconsistent, teams may not see risk clearly. Poor update quality can hide delay trends and make risk reporting unreliable.
Conclusion
A Risk Breakdown Structure is one of the most practical tools construction teams can use to bring order to project uncertainty.
By organizing risks into clear categories and subcategories, an RBS helps teams identify potential issues earlier, communicate more effectively, assign ownership, prioritize mitigation strategies, and align risk planning with project objectives.
But an RBS should not stop at categorization. In construction, risk becomes most actionable when it is connected to the schedule. Delays, float erosion, missed milestones, logic changes, poor update quality, and end-date exposure all provide evidence of which risks are actually affecting project performance.
That is where SmartPM strengthens the risk management process. An RBS helps teams define and organize risk categories. SmartPM helps teams identify which risks are showing up in CPM schedule data, giving project teams the visibility they need to act earlier, forecast more accurately, and improve project controls.
For teams that want risk planning to become more than a static document, the next step is to connect the RBS to schedule analytics, project controls workflows, and ongoing performance monitoring.
Related Reading
- Top 10 Types of Construction Schedules
- Best Construction Scheduling Software: Top Tools Compared
- The Ultimate Guide to Construction Project Controls
- Risk Assessment in Construction Projects: A Step-by-Step Guide
- Construction Timelines Explained
- Top 7 Construction Project Control Tools: Reviewed
- Construction Gantt Chart Complete Guide
- The Complete Guide to Construction Project Planning
Frequently Asked Questions
-
An RBS categorizes potential risks in a hierarchical structure, helping teams manage uncertainty throughout the project life cycle. A WBS, on the other hand, breaks down the project scope into manageable tasks and deliverables. Integrating both ensures risks are directly aligned with specific work packages for better control.
-
An RBS enhances scheduling by identifying risks tied to specific tasks or milestones, allowing teams to build buffers, adjust timelines, and implement mitigation strategies early. This approach reduces delays and boosts schedule reliability.
-
Yes. By quantifying the impact and likelihood of each risk, an RBS supports better contingency planning and cost forecasting. It helps teams allocate resources where risk exposure is highest, avoiding unexpected overruns.
-
While not mandatory, an RBS is highly recommended for projects of any complexity. It’s especially valuable in large-scale or high-stakes construction projects where risks are numerous and impacts can be significant.
-
An RBS should be reviewed and updated regularly, ideally at each major project milestone or schedule update. Construction environments change quickly, so continuous risk reassessment is key to staying ahead of emerging threats.
-
Project teams often use Excel templates, scheduling software, or integrated project management platforms to build and maintain their RBS. These tools help standardize risk tracking and ensure visibility across teams.
-
SmartPM’s schedule analytics platform can be used alongside an RBS to flag schedule-driven risks in real time. It enables proactive planning, assigns ownership, and tracks mitigation efforts, giving construction teams a powerful edge in managing project uncertainty.
