What Is Project Controls in Construction? The Complete Guide

Project controls is one of the most misunderstood functions in construction - and the teams that get it right build it around schedule data.

Most construction teams believe they have project controls in place. What they actually have, in many cases, is reporting.

That distinction matters more than most project leaders realize. Construction project controls are the systems, people, processes, and analytical frameworks that allow teams to detect problems early, quantify impact, and make decisions while there is still time to course-correct.

Reporting tells you what happened. Controls tell you what is about to happen and give you enough lead time to do something about it.

Understanding construction project controls, what they actually are, and how they differ from reporting, is one of the most important things a project controls department can get right.

This guide covers what construction project controls actually involve, why the schedule is the connective tissue of every discipline within controls, how to build a functional system regardless of team size, and what separates construction firms that consistently deliver on time from those that are always reacting.

Table of Contents

What Is Project Controls in Construction?

Construction project controls are the people, processes, and tools used to plan, measure, analyze, and forecast project performance across schedule, cost, scope, and risk. The purpose is to give project teams and leadership the data they need to make decisions while decisions can still change outcomes.

The operative phrase there is "while decisions can still change outcomes." That is what separates controls from reporting. A status report tells you where you stand at the end of the month. A construction project control system tells you, in real time, whether the trajectory of the construction project is pointing toward on-time delivery or toward a delay, and by how much.

Construction project controls help organizations maintain alignment between the project's goals and actual field conditions. They are the mechanism by which the project schedule, the project budget, and project scope are continuously verified against what is actually happening.

When that verification reveals a gap, a delay accumulating, a cost trending over, or a scope change that has not been formally evaluated, the controls system surfaces it early enough to respond.

AACE International, the leading professional body for cost engineering and project controls, defines a project controls plan as the document that describes specific processes, procedures, tools, and systems that guide and support effective project control. In practice, that means the controls plan is not a spreadsheet or a weekly meeting. It is a structured framework that runs parallel to the construction project from day one.

A critical point worth clarifying: construction project controls are not the same thing as construction management software. Tools like Procore and Autodesk Construction Cloud are project management platforms. They organize information, manage documents, and connect teams. Project controls go a layer deeper. They analyze the data those platforms generate to evaluate performance against the plan.

Project Controls vs. Construction Management: Why the Distinction Matters

Project management and project controls are related but serve fundamentally different functions. Conflating them is one of the most common reasons organizations think they have controls in place when they do not.



Construction Management

Project Controls

Function

Leadership and execution

Analysis and measurement

Primary question

Is the work getting done?

Is the work happening as planned and where are the main risks towards timely delivery?

Core responsibilities

Resource allocation, subcontractor management, contract administration, stakeholder communication, safety, delivery execution

Schedule analysis, cost management, scope control, earned value, risk quantification, variance analysis, forecasting

Who drives it

Project managers

Project controls managers, project controllers, controls engineers, schedulers

Data focus

Progress and coordination

Performance against baseline

Output

Decisions and actions

Analysis and forecasts

Schedule management and cost management are the two disciplines within project controls that require the most rigorous data infrastructure. Neither can be done reliably without consistent schedule updates, accurate cost tracking, and a system that connects the two.

Think of it this way. Project managers steer the vehicle. Project controls is the instrumentation panel: it tells you your speed, whether the fuel is running low, and whether the road ahead has a problem you cannot yet see.

Neither function works well without the other. But on many mid-market construction projects, the controls function either does not exist as a formal discipline or has been absorbed into the project management role in a way that compromises both. When one person is simultaneously responsible for making decisions and objectively measuring the quality of those decisions, the controls function loses its integrity.

What Are the Key Components of Project Controls in Construction?

Construction project controls span multiple disciplines that operate in parallel throughout the project lifecycle. The schedule is the connective tissue. Every other component either feeds into the schedule or is affected by it. Understanding the key components of construction project controls is the foundation for building a system that actually works.

Component

What It Covers

Why It Depends on the Schedule

Schedule Control

Monitoring progress against the CPM baseline; identifying delays and float erosion

Everything else is measured relative to schedule performance

Cost Management

Budget tracking, cost forecasting, tracking expenses and actual costs against project costs

Cost exposure is rarely visible without an accurate, up-to-date schedule

Scope Control

Managing project scope, change order intake, contract compliance; preventing scope creep

Scope changes directly impact schedule logic and cost schedule alignment

Risk Management

Identifying potential risks, quantifying exposure, and developing mitigation strategies

Risk probability is assessed against schedule float and contingency

Change Management

Evaluating and documenting changes through a robust change management process

Change impacts are only defensible with a reliable schedule baseline

Quality Control

Verifying work meets spec; managing rework using defined quality metrics

Rework creates unplanned schedule consumption and float erosion

Data Structure and Reporting

Organizing project data for accurate, defensible reports; enabling data sharing across project teams

Reports are only as reliable as the quality of the underlying schedule inputs

The key benefits of this integrated framework are visibility and speed of response. Construction project controls help teams catch problems when they are still small. Cost control, scope control, and quality control all become more tractable when there is a reliable, up-to-date project schedule to measure against.

Scope creep is one of the clearest examples: when project scope is not continuously verified against the baseline through rigorous scope control, small additions accumulate into significant schedule and cost exposure before anyone has formally reviewed the impact.

The table above also reflects how these components interact in practice. Project teams that treat them as independent workstreams often find, when things go wrong, that the breakdown happened at the intersection.

Why Do Construction Projects Fail Without Effective Project Controls?

Construction projects fail without effective project controls because the problems that cause failure are rarely visible until they have already done serious damage. Project control efforts that exist only on paper, without the analytical infrastructure to back them up, offer no real protection.

Construction projects fail without effective project controls because the problems that cause failure are rarely visible until they have already done serious damage. Project control efforts that exist only on paper, without the analytical infrastructure to back them up, offer no real protection.

According to McKinsey research, 98 percent of megaprojects suffer cost overruns of more than 30 percent, and 77 percent are at least 40 percent late. Those figures apply to the largest, most resource-intensive projects in the construction industry. But the same dynamics play out at the $20M commercial build and the $150M healthcare facility. The scale changes. The failure pattern does not.

The Failure Pattern

The breakdown almost always starts the same way. A construction project kicks off with a schedule that has not been validated for quality. Activities are missing logic ties, float is inflated, and the critical sequence is not accurate. Nobody flags it - the project is early, morale is high, and there is no system in place to measure schedule integrity objectively.

Three months in, the project starts running behind. Project managers scramble, add resources, compress the schedule. Six months in, the delay is large enough that someone has to explain it to the owner - and by that point, the forensic record is a mess.

The Cost of Catching Problems Late

Strict project controls interrupt this pattern by establishing a performance baseline early, continuously monitoring progress against it, and surfacing variance while the variance is still small enough to address. A sound risk management plan, built during project planning rather than after the fact, enables project teams to identify potential risks before they materialize and develop mitigation strategies while options still exist.

The earlier a problem is identified, the cheaper it is to fix. Direct and indirect costs both escalate when project risks go undetected. Indirect costs, including extended general conditions, lost productivity, and acceleration premiums, often exceed the direct cost of the original problem. Project control efforts that surface issues early compress that exposure significantly.

“In forensic analysis, the failure almost always starts with a baseline schedule that no one validated. The logic is loose, float is inflated, and the critical path isn’t real. The team starts executing against it anyway, and by the time the data shows a problem, they’re already months behind with no clean way to recover.” - Mike Pink, CEO of SmartPM.

The Role of the Critical Path Schedule in Construction Project Controls

No section of this guide is more important than this one, and no section is more frequently skipped in articles about project controls.

The Critical Path Method (CPM) schedule is the backbone of construction project controls. CPM is a network-based planning methodology that:

  • Defines the sequence of activities required to complete a construction project
  • Identifies the longest chain of dependent activities that determines the earliest possible completion date
  • Calculates the available float for every non-critical activity
  • Maps task dependencies so that every downstream control has an accurate foundation to measure against

When deployed properly, CPM helps teams prioritize what they need to do today in order to finish the project on time. In many questions, the delivery date could be months or years down the road – meaning, effective prioritization of costs, resources, and manpower is key.

When task dependencies are incorrectly defined or missing, the schedule cannot accurately reflect reality, and every downstream control is compromised.

Why Every Other Control Depends on the Schedule

The CPM schedule is not one input among many. It is the input everything else is measured against:

Control Discipline

What It Needs from the Schedule

Cost schedule integration

Reliable milestones to tie expenditure curves to

Risk management

Float reserves to assess probability and severity of potential risks

Change management

Schedule logic to evaluate time impact of changes

Earned value

Reliable activity completion data for variance calculations

Consistent schedule updates and analysis are what keep the entire project management and project controls function grounded in reality rather than assumptions.

Schedule Quality vs. Schedule Existence

If the schedule is wrong, every other control is measuring against a flawed baseline.

This is a distinction the industry still gets wrong consistently. A schedule can exist, be submitted on time, look complete, and still be analytically useless. A schedule with any of the following problems will not tell you where the construction project is headed, it will tell you what someone wants you to believe:

  • Missing or broken activity logic
  • Excessive out-of-sequence progress
  • Inflated float
  • A broken critical sequence

The data structure of a CPM schedule, how activities are sequenced, coded, and logic-tied, is what determines whether it can be used as a genuine controls instrument.

How Schedule Quality Is Measured

The DCMA 14-point check provides a standardized framework for evaluating CPM schedule integrity across criteria including logic density, float distribution, and constraint usage. It is the benchmark used across federal projects and increasingly referenced by sophisticated owners and GCs who want to verify that a submitted schedule is analytically sound.

However, the DCMA’s binary pass/fail grading system leaves little room for customization according to project type, contract specifications, or organizational realities. That’s why SmartPM's platform runs 40+ schedule quality metrics, including the full DCMA 14-point assessment, on every schedule update uploaded to the system.

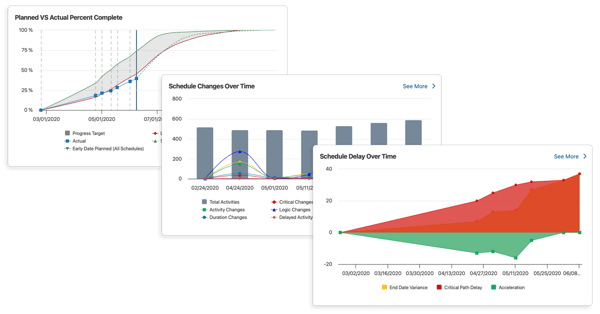

The result is an objective quality grade for each schedule, updated every time a new progress submission is received and customized to the projects and teams delivering the work. The quality of the underlying data is the foundation of everything else.

SmartPM generates an objective schedule quality grade on every submission, giving project controls teams an instant read on schedule integrity.

How to Implement a Project Control System on a Construction Site

Implementing a project control system is not a single event. It is an ongoing process that spans the entire project lifecycle. Here is how to approach it in practice, phase by phase.

Phase 1: Project Initiation

This is where most teams underinvest. During initiation, the construction project controls framework should be defined before any work begins. That means establishing a high-quality CPM baseline, defining key performance indicators, setting up the reporting cadence, identifying key stakeholders and their reporting needs, and conducting an initial schedule quality review.

Project managers and project controllers should align at this stage on exactly how project scope will be documented, how change management requests will be evaluated, and what thresholds will trigger escalation. A baseline that has not been validated for CPM integrity is not a baseline. It is a starting point for a future dispute.

Phase 2: Project Planning

During project planning, the CPM schedule is developed and formally baselined. Project controllers should evaluate the schedule against quality standards, confirm that milestones align with contractual commitments, and establish cost-loaded activities where earned value tracking is required.

A risk management plan should also be developed at this stage, identifying potential risks and outlining mitigation strategies before execution begins. Project planning is also when project objectives are formally documented and linked to measurable benchmarks that the controls system will track.

Want to see how SmartPM grades your schedule at baseline, before execution begins? Book a demo and we'll walk you through it.

Phase 3: Execution

Once work begins, the controls system shifts to active monitoring. Schedule updates are submitted at the agreed cadence, typically monthly. Each update should be analyzed for variance from the baseline, float erosion, logic modifications, and cost schedule alignment.

Actual costs are tracked against project costs. Change orders are evaluated for time and cost impact before execution, and after to quantify reality. Additionally, all of this needs to be communicated proactively so everyone can work together with up-to-date and accurate data for sound business decisions. A systematic approach to change management at this phase prevents scope creep from accumulating quietly and eroding the project budget.

Phase 4: Monitoring and Forecasting

This phase runs parallel to execution and is where construction project controls produce their most tangible value. Forecast completion dates are updated based on current progress rates. Float erosion trends are tracked to identify activities at risk of becoming critical.

Cost-at-completion projections are refined as actual costs accumulate. Tracking progress at regular intervals and sharing that analysis with project stakeholders in a clear format keeps decision-making grounded in data rather than intuition.

Phase 5: Closeout

At closeout, the controls record becomes the forensic archive. Every baseline change, schedule update, variance report, and change management evaluation should be preserved and organized. If a claim arises, this record is the foundation of a defensible analysis. If no claim arises, it is the data set that informs future project planning and bid strategy.

Who Manages Construction Project Controls?

Construction project controls are managed by a combination of specialized roles that, on larger projects, form a dedicated project controls department.

Project Controls Engineers

Project Controls Engineers are responsible for data collection, schedule analysis, cost tracking, and variance reporting. They are the analytical engine of the controls function and the primary source of project data that feeds into every other reporting and decision-making process.

Project Controls Managers

Project Controls Managers oversee the entire controls framework, coordinate with project managers, and ensure that performance metrics are consistently applied across the construction project or portfolio. They also play a key role in how construction project controls help leadership understand and act on project risk.

Project Controllers

Project Controllers focus on specific disciplines: scheduling, cost engineering, risk management, or claims support. On highly complex projects, these roles are separated. On mid-market projects, one person often covers multiple disciplines.

The honest challenge for many GCs, particularly those in the $50M to $200M annual volume range, is that this kind of staffing is not always feasible. Building a dedicated project controls department requires budget and time, and the skills needed to manage a formal controls function are genuinely difficult to find and retain.

This is precisely the gap that SmartPM was built to address. General contractors of all sizes can use SmartPM to automate the analytical work that would otherwise require a full project controls department: schedule quality scoring, variance tracking, delay analysis, and automated reporting.

SmartPM can also integrate cost and schedule into a single platform, so that cost management and schedule analysis work together rather than in separate silos via business intelligence dashboards. Project controls help the organization scale without requiring every project to have a dedicated controls engineer. A mid-market GC running five to ten projects simultaneously can operate with the same analytical rigor as an ENR Top 50 firm, without building out a large internal team.

What to Look for in Construction Project Controls Software

Not all project controls platforms are equal, and the differences are not always obvious from a product demo. Construction project controls software should do more than display data. It should analyze it. Here is how to evaluate your options, and why these criteria matter for successful project delivery.

Does it use a real CPM engine?

Some platforms import schedule files and display them visually. They show you a Gantt chart, maybe some cost schedule summaries. But they are not performing mathematical operations on the underlying data. They are visualizing it.

A platform with a genuine CPM engine can track milestones, evaluate recovery options, and run a forensic delay analysis. A visualization tool cannot. This distinction is critical for construction project success when disputes arise, and analysis must be defensible.

Does it produce defensible analysis?

If a construction project ends up in a dispute, will the data from this platform hold up under scrutiny? Forensic delay analysis requires a documented, traceable record of every schedule update, every variance, every baseline change.

Not every platform maintains that kind of audit trail. This is where construction project controls help or fail their users most visibly.

Does it support cost control and quality control?

The key benefits of an integrated controls platform extend beyond the schedule. Look for tools that support cost control by connecting schedule milestones to budget tracking, and that enforce quality control checkpoints so that rework and deficiency data feed back into the schedule analysis.

A systematic approach to both disciplines, built into the platform rather than bolted on through separate spreadsheets, is what separates a genuine controls tool from a reporting dashboard.

Does it measure schedule quality objectively?

A platform should tell you whether the schedules being submitted are analytically sound, not just whether they were received on time. Look for platforms that assess schedules against objective quality criteria, including DCMA standards. Key performance indicators for schedule health should be visible and updated with every submission.

Does it integrate cost and schedule data?

A platform that integrates cost and schedule in a single view enables earned value analysis and gives project teams visibility into the relationship between schedule performance and project costs. If your platform connects cost and schedule, project managers have one coherent picture instead of two disconnected data sets. This is one of the clearest markers of a true project management and controls tool versus a standalone reporting product.

Does it integrate with your existing tools?

SmartPM integrates with Primavera P6, Microsoft Project, Phoenix Project Manager, Procore, Autodesk Construction Cloud, Egnyte, and others. The value is in the analytics layer; it sits on top of the tools your teams already use and makes them more useful.

Does it scale across a portfolio?

A platform that gives portfolio-level visibility, letting leadership and project managers see schedule health and risk flags across all active projects simultaneously, is considerably rarer and considerably more valuable than a single-project tool. Successful project delivery at scale requires portfolio-level visibility, not just project-by-project reporting.

When portfolio data is centralized, teams can also account for inactive projects rather than ignoring them. Completed or paused work becomes part of the dataset, allowing organizations to benchmark performance against historical delivery, not just current activity. This creates a more stable baseline for schedule quality, delay trends, and compression risk.

Benchmarking across active and inactive projects also highlights patterns that are hard to see at the project level. Leadership can quickly identify which regions, project types, or teams consistently maintain stronger schedule quality and which ones show recurring risk signals. That level of comparison enables organizations to move from reactive oversight to continuous improvement.

focus-your-attention

Common Challenges in Project Controls Implementation

Understanding these challenges in advance makes implementation significantly smoother. Most of them are solvable. All of them are predictable.

Challenge

Why It Happens

How to Address It

Resistance from project teams

Objective performance tracking feels threatening to teams used to operating without structured accountability

Frame controls as a tool that gives project teams better data, not an audit function. Project managers who understand the benefit become the strongest internal advocates and avoid a whole lot of unnecessary stress

Poor baseline quality

The initial CPM schedule is submitted without being validated for logic, float, and schedule integrity

Conduct a formal baseline review before the project starts. Verify that activities are properly coded, sequenced, and logic-tied before the controls system goes live

Inconsistent update cadence

Resource constraints in staffing, time, or budget lead to irregular schedule submissions

Define the update cadence contractually where possible. Monthly updates are the industry standard but weekly updates are ideal. When updates slip, the gap between reality and the plan widens faster than most teams expect

Data silos between cost and schedule

Cost management and schedule tracking are handled in separate systems that never share information

Invest in integrated platforms that connect cost and schedule in a single view. Overcoming data silos is one of the highest-leverage improvements a project controls department can make

Reporting without analysis

Teams focus on producing reports rather than drawing conclusions from the data

Build analysis into the controls workflow from the start. A report shows what happened. Analysis explains why, what the trajectory means, and what decisions need to be made

Real-World Results: How Construction Teams Use SmartPM for Project Controls

The practical value of construction project controls is easiest to understand through what happens when they work as intended.

At Frampton Construction, before SmartPM, the controls process was largely manual. Schedule reviews, variance tracking, and reporting were done by hand. According to Josh Schlechty, the firm's leader who implemented SmartPM across two ENR-ranked firms:

"Before SmartPM, I was either working late at the office or jumping on my computer after my family went to bed. Using SmartPM, I can do in 10 minutes what used to take me 2 hours or more."

The issue was not effort. It was that the manual process made it impossible to scale scheduling discipline across an organization. SmartPM's automation of the controls workflow is what made successful project delivery repeatable.

At Columbia Ventures, the controls capability enabled something different: the ability to remove emotion from difficult conversations. When a contractor dispute arose, SmartPM's project data gave the team a factual, objective record of project performance that let data drive negotiation rather than competing narratives.

At Wood Partners, the shift was from reactive to proactive. As their team described it, SmartPM moved them from waiting with their fingers crossed for the ball to drop, to driving successful construction project outcomes from the front.

Each of these reflects a different dimension of what project controls actually deliver: time savings, defensibility, and proactive visibility.

Ready to see what this looks like on your projects?

Book a SmartPM demo and walk through the platform with one of our team members.

Frequently Asked Questions



Previous Post: Construction Timelines Explained: A Step-by-Step Guide
Construction Timelines Explained: A Step-by-Step Guide

Construction Timelines Explained: A Step-by-Step Guide

Next Post: The Complete Guide to Gantt Charts in Construction Management
The Complete Guide to Gantt Charts in Construction Management
